Water Supply Crisis Looms as Drought Restrictions Approach

September 23, 2024 | Lynn City, Essex County, Massachusetts


This article was created by AI summarizing key points discussed. AI makes mistakes, so for full details and context, please refer to the video of the full meeting. Please report any errors so we can fix them. Report an error »

Water Supply Crisis Looms as Drought Restrictions Approach

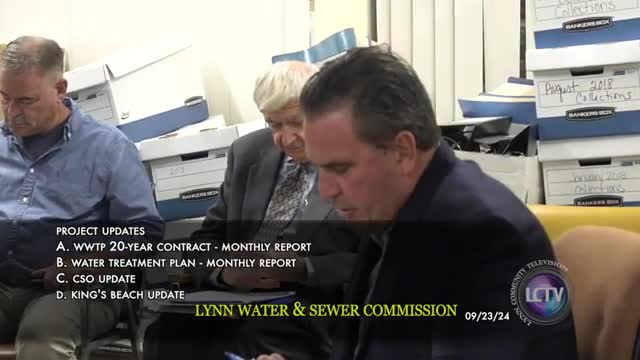

During a recent government meeting, officials provided updates on several key infrastructure projects, highlighting both progress and challenges. The ongoing construction at the wastewater treatment plant is approximately 77% complete, with significant milestones achieved. The project, which has a budget of $74 million, is expected to result in substantial debt service payments in the near future.

Construction activities include the installation of aeration trains, liquid oxygen systems, and pump stations, with five pump stations currently itemized in the project report. However, officials noted ongoing issues with the Department of Environmental Protection (DEP) regarding payment approvals for change orders, although they are optimistic about resolving these matters.

In terms of water supply, the current capacity stands at 57%, below the seasonal average of 65%. With 28 days of no rainfall, reservoir levels have dropped, prompting officials to anticipate involuntary water curtailments as early as next week. A water ban could be implemented if levels fall below 50%. Communication about any restrictions will be disseminated through local newspapers, signage, and the city’s website.

Updates on the Combined Sewer Overflow (CSO) project revealed that construction on the pump station is ongoing, with significant progress made on the installation of a 54-inch force main. However, the project is facing delays, with a projected completion pushed back by approximately six months due to complications with utility installations. Despite these setbacks, officials confirmed that there are currently no additional costs associated with the delays.

The meeting concluded with discussions about potential celebrations for the completion of the Bennett Street pump station, indicating a community-oriented approach to project milestones.
