Power Outage Crisis Hits High School Stadium Project

July 02, 2024 | Lexington 05, School Districts, South Carolina



Black Friday Offer

Get Lifetime Access to Full Government Meeting Transcripts

$99/year $199 LIFETIME

Lifetime access to full videos, transcriptions, searches & alerts • County, city, state & federal

Full Videos
Transcripts
Unlimited Searches
Real-Time Alerts
AI Summaries
Claim Your Spot Now

Limited Spots • 30-day guarantee

This article was created by AI summarizing key points discussed. AI makes mistakes, so for full details and context, please refer to the video of the full meeting. Please report any errors so we can fix them. Report an error »

Power Outage Crisis Hits High School Stadium Project
In a recent government meeting, officials discussed significant power issues affecting the local high school, particularly the press box area. The problems began a few weeks ago, prompting communication with the utility company regarding transformer changes, which ultimately did not resolve the issues. The situation escalated when power was completely lost at the press box, leading to the discovery that the feeder cables connecting the transformer to the main electrical room had failed.

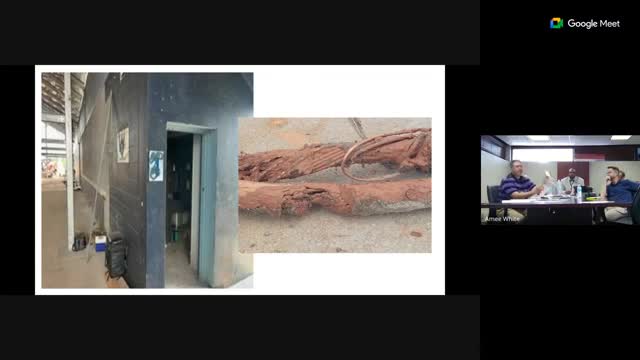

An investigation revealed that the cables had been improperly installed years ago, with damaged sheathing inadequately repaired with tape. As a result, the cables could no longer function, necessitating immediate action to restore power. Portable generators and spot coolers were brought in to maintain conditions in the building, which is currently without power.

The proposed solution involves installing a new pool box and running new conduit from the transformer to the electrical room, with plans to run the conduit exposed along the stadium to avoid complications from existing underground utilities. This decision was made after assessing the risks of using old conduit, which is believed to be over 50 years old and potentially compromised.

Officials emphasized the urgency of the repairs, especially given the high temperatures and humidity that could lead to biological growth within the building. They assured that the new installation would not compromise safety, security, or accessibility, and that no significant sacrifices would be made in the overall construction project.

Concerns were raised about the costs associated with the changes, particularly regarding utility fees and the potential for additional expenses related to other conduit repairs. However, officials indicated that the project remains within budget, with funds being reallocated from other line items to cover the necessary work.

The meeting underscored the importance of addressing the electrical issues promptly to ensure the functionality of the press box and the overall project timeline, which has already faced delays.
