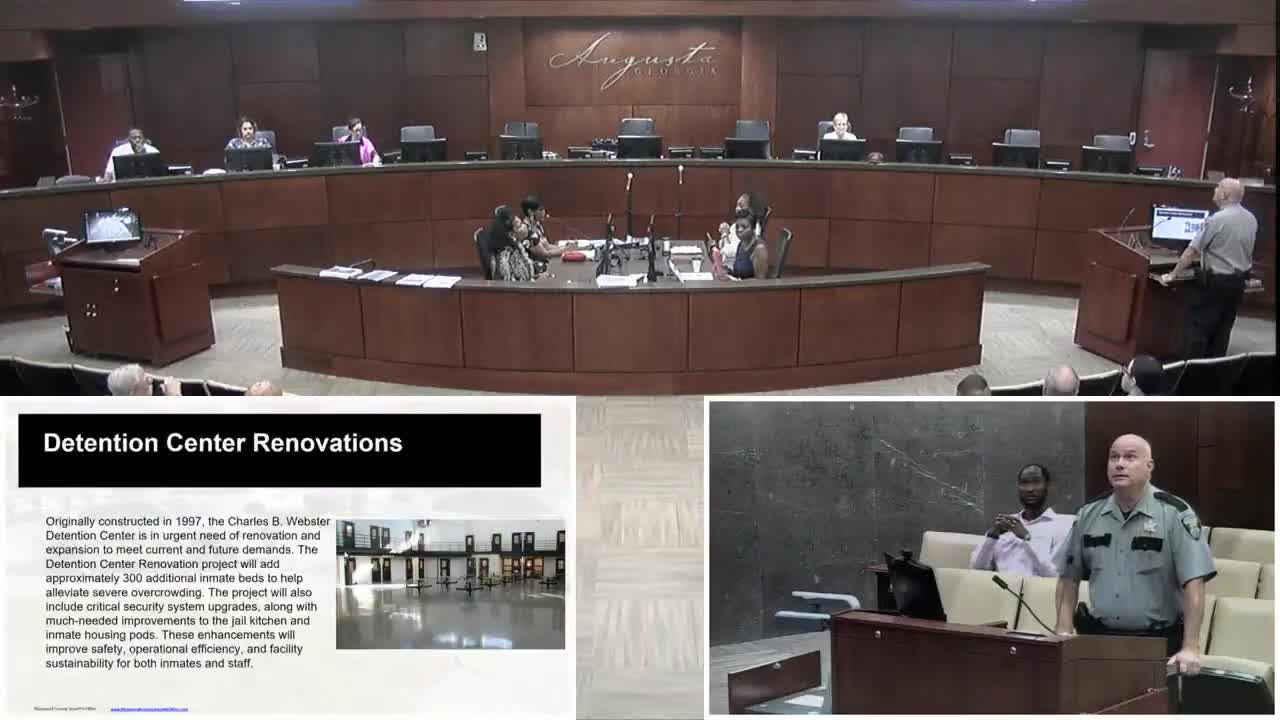

The Augusta City Commission convened on June 28, 2025, to discuss critical updates regarding the Charles B. Webb Detention Center, focusing on a proposed renovation and expansion project aimed at addressing public safety and infrastructure needs in Richmond County.
The meeting began with an overview of the detention center, originally constructed in 1997, which currently houses approximately 1,350 inmates daily, significantly exceeding its designed capacity of 1,077. Officials emphasized that the facility's overcrowding is not merely a matter of numbers; it involves complex classifications of inmates, including separating gang members and those with mental health issues. This situation has led to a pressing need for additional housing capacity, prompting the proposal for an expansion that would add 300 beds.
The discussion highlighted the urgent nature of the project, with officials warning that without immediate investment, conditions could worsen, potentially leading to legal challenges and federal scrutiny. Comparisons were drawn to similar situations in Atlanta, where significant financial resources are being allocated to address jail conditions.
The proposed budget for the project totals $115 million, with $15 million earmarked for renovations of the existing facility and $85 million for the construction of the new beds. Officials noted that inflation and rising construction costs necessitated a budget of $100 million for the new beds. The anticipated annual operating cost for the expanded facility is projected at $3 million.
The timeline for the project could see completion by 2028, contingent on securing funding. Currently, the most viable funding source appears to be the Special Purpose Local Option Sales Tax (SPLOST), although other avenues may be explored.
Staffing needs were also addressed, with officials explaining that hiring one new employee effectively requires the recruitment of 4.5 staff members due to the 24/7 operational demands of the facility. The estimated cost for staffing, including salaries and benefits, is projected at $2.56 million.
The meeting concluded with an invitation for questions from the commissioners, indicating a collaborative approach to addressing the pressing issues surrounding the detention center. The discussions underscored the importance of timely action to enhance public safety and improve conditions within the facility.
