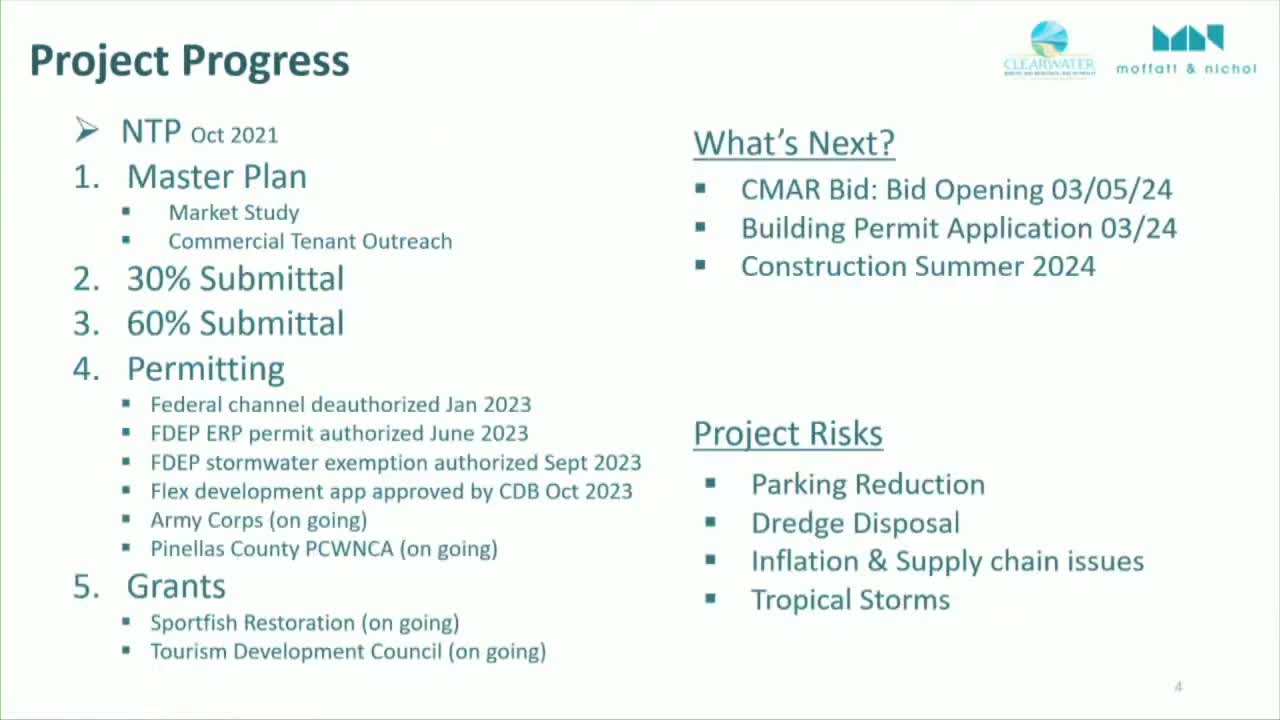

During the recent Marine Advisory Board meeting in Clearwater, significant progress was reported on a major construction project that has been in the works since October 2021. The project, which includes a comprehensive master plan, has reached several key milestones, including the completion of 30% and 60% design drawings, as well as obtaining necessary environmental permits.
One of the most notable developments is the deauthorization of a federal channel that previously posed a barrier to the project's southern expansion. This change was facilitated by an act of Congress, championed by Eric Gandy, which has cleared a path for further development. Additionally, the Florida Department of Environmental Protection (FDEP) has granted the environmental resource permit, and the Army Corps of Engineers is in the process of finalizing their permit, with positive indications reported.
The meeting also highlighted the ongoing pursuit of two grants to support the project. Recently, bids were opened for the Construction Manager at Risk (CMAR), who will oversee the construction process. Four bids were submitted, and the selection of the lowest responsible bidder is currently underway, a process expected to take several weeks due to the complexity of the project.
As part of the preparations, the city has begun submitting applications for 16 individual building permits, a process that is anticipated to be lengthy. The planning and development department is actively involved in this phase, ensuring all necessary approvals are secured.
However, the project does come with risks, particularly concerning parking. During construction, there will be a reduction in available parking spaces, which may impact local businesses and visitors. The final design will also result in a permanent loss of some parking spaces due to the relocation of kiosks.
Overall, the meeting underscored the city's commitment to advancing this significant project, which promises to enhance the Clearwater waterfront while navigating the challenges associated with construction and community impact. As the project progresses, stakeholders will continue to monitor developments closely, ensuring that both the construction timeline and community needs are balanced effectively.
