Olive Branch approves series of road, striping and park construction change orders; closes multiple projects

October 08, 2025 | Olive Branch, DeSoto County, Mississippi


This article was created by AI summarizing key points discussed. AI makes mistakes, so for full details and context, please refer to the video of the full meeting. Please report any errors so we can fix them. Report an error »

Olive Branch approves series of road, striping and park construction change orders; closes multiple projects

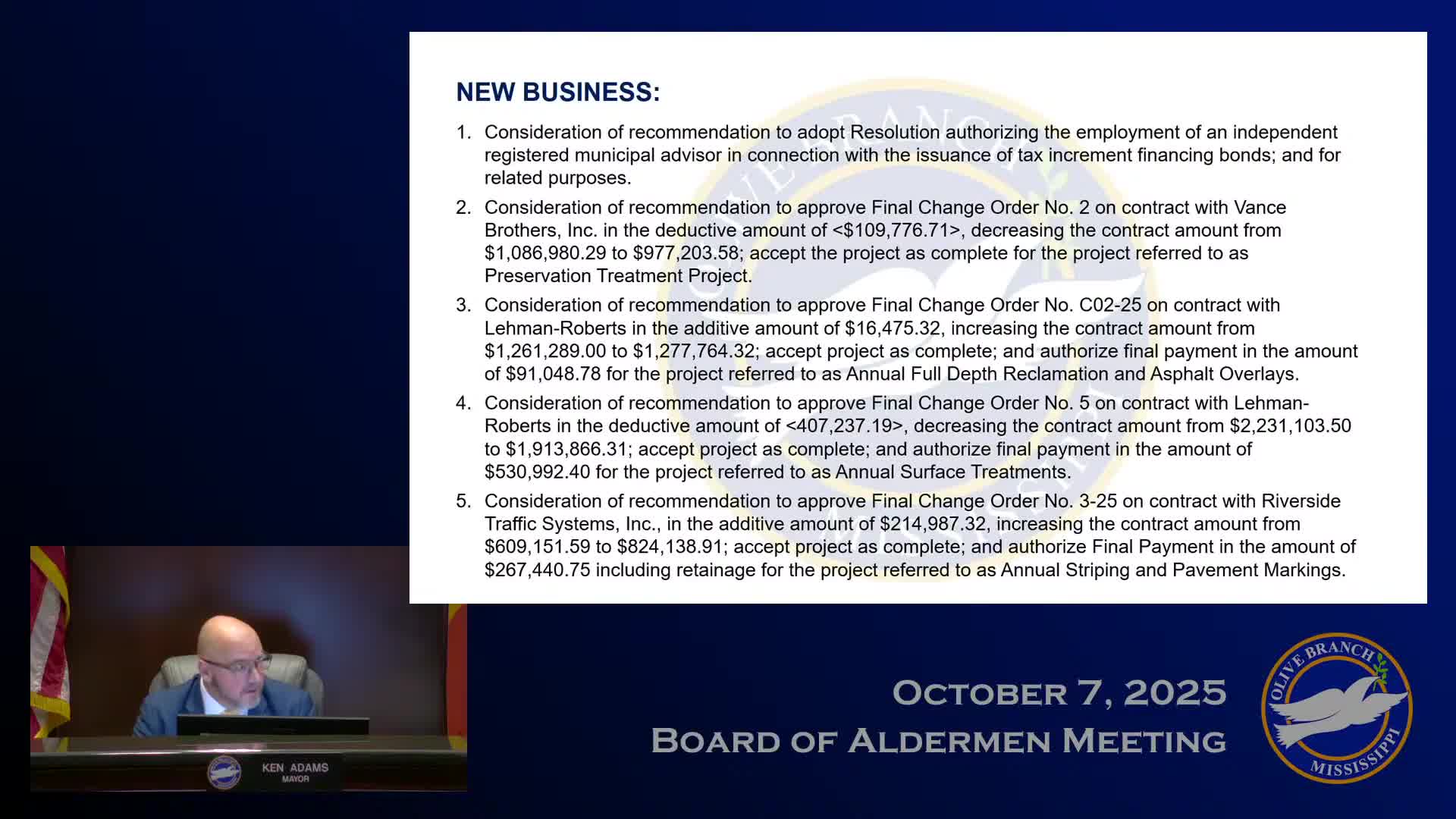

The Olive Branch board on Oct. 7 approved a package of final change orders and contractor closeouts covering road preservation, overlays, striping, water and gas improvements, and a new pickleball facility, authorizing final payments and several additional service agreements.

City staff presented a series of items that closed earlier-year contracts and authorized follow-up work. Mister Swims, presenting the roadway preservation and overlay items, said the city ran under some contract line items and recommended deductive change orders where work came in below estimates; in other contracts, fuel and scope adjustments led to modest increases.

The board approved a $109,776.71 deductive change order on the Vance Brothers Inc. contract, lowering that contract from $1,086,980.29 to $977,203.58 and accepting the preservation-treatment project as complete. Motion to approve was made by Mister Dixon and seconded by Mister Wallace; the motion carried.

The board approved final closeout on two Lehman Roberts Company contracts: an additive change order of $16,475.32 (increasing that contract from $1,261,289 to $1,277,764.32) and authorization of a final payment of $91,048.78 for annual full-depth reclamation and asphalt overlays; and a deductive change order of $407,237.19 (decreasing a separate Lehman Roberts contract from $2,231,103.50 to $1,823,866.31) and authorization of a final payment of $530,992.40 for annual surface treatments. Mister Earhart moved the first Lehman Roberts item; Mister Wallace moved the larger deductive closeout; both motions passed.

The board approved a $214,987.32 additive change order for Riverside Traffic Systems Inc., raising that contract from $609,151.59 to $824,138.91, and accepted final payment including retainage of $267,440.75 for annual striping and pavement markings. Mister Collins moved the item and Miss Hamilton seconded; the motion carried.

For the Dollar Branch City Park project, the board approved change order No. 1 with Alexander Construction LLC in the additive amount of $32,690.75 (increasing that contract to $1,001,598.38) to address an unexpectedly mislocated manhole and associated sewer work to serve restrooms at the new pickleball courts. The motion was made by Mister Wallace and seconded by Miss Aldridge; it passed.

The board approved change order No. 3 with Argo Construction Corporation in the additive amount of $18,525 for Maywood gas and water improvements, covering added encased water line work and relocation of meters. The motion was made by Mister Earhart and seconded by Miss Hamilton; it passed.

The board also approved a professional services agreement with Cruise Engineering and Consulting LLC not to exceed $310,000 for design, survey, construction engineering, inspection and permitting for the gas system upgrade on Center Hill Road Phase 2. Mister Collins moved and Mister Wallace seconded; the motion carried.

All items were approved by voice vote with the board saying "Aye." No individual roll-call tallies were recorded in the meeting transcript.

Board members noted that five of eight new-business items that evening concerned pavement and street work, and the mayor observed the actions reflected a commitment to maintaining city streets and infrastructure.
