District 204 outlines large capital program: vestibules, turf fields, auditorium work and LED upgrades

September 08, 2025 | Indian Prairie CUSD 204, School Boards, Illinois


This article was created by AI summarizing key points discussed. AI makes mistakes, so for full details and context, please refer to the video of the full meeting. Please report any errors so we can fix them. Report an error »

District 204 outlines large capital program: vestibules, turf fields, auditorium work and LED upgrades
Indian Prairie School District 204 facility and construction staff presented a multi-year update on the district's Safer, Stronger 204 capital program during the Sept. 8 board meeting, summarizing completed summer work, upcoming projects and budget oversight.

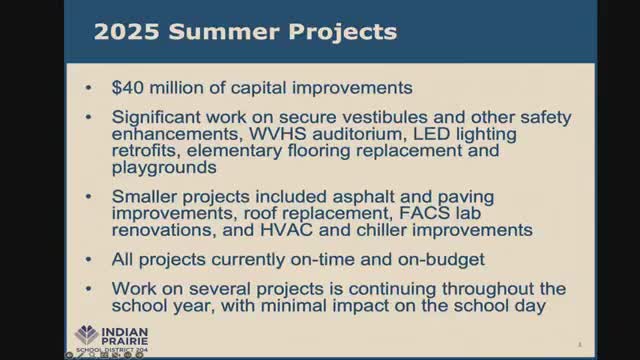

Staff reported roughly $40,000,000 in capital work completed or underway during the summer, including secure vestibule construction at 11 elementary schools, auditorium renovations at Waubonsee Valley High School, playground replacements and a continuing program of elementary flooring replacements. The district said most summer projects were on schedule and on budget.

Why it matters: the referendum-funded capital program supports safety, energy-efficiency, accessibility and instructional spaces across the district. Facility leaders emphasized that all work aligns with the district's Master Facility Plan and the commitments in the voter-approved Safer, Stronger 204 referendum.

Key projects and timeline: the district plans secured vestibules at 11 additional buildings (elementary and middle schools), with five middle schools requiring main-office relocations to create secure entries. The three comprehensive high-school projects include Neuqua Valley, Waubonsee Valley and Metea Valley; planned work includes field-turf athletic surfaces at all three high schools, track replacement at Metea and Neuqua, and a larger stadium renovation at Waubonsee that will add accessible bleachers, upgraded restrooms, concessions and a new scoreboard.

Energy and sustainability work: the district is completing an LED lighting retrofit across buildings (12 buildings in progress, districtwide by 2026-27) and will issue an RFP to study rooftop solar feasibility and possible battery storage at selected sites. Staff said preliminary estimates indicate a payback in the mid single-digit years where incentives and roof conditions make solar viable and that dashboards will report actual usage and savings if projects proceed.

Community engagement and local participation: the district engaged construction managers, architects and contractors and described plans to host vendor fairs, QR-linked project dashboards, live progress photos and behind-the-fence student tours and internships. The district plans to prioritize local subcontractor participation and MWBE outreach during bid solicitation.

Budget and oversight: facility staff reiterated that the overall capital program budget is being tracked across nine separate projects (total referenced as $466,000,000 in program planning). For Waubonsee Valley, the board was shown phase-level budgets and a remaining contingency balance; staff said contingency releases can seed additional scope such as landscaping and tree planting as projects progress.

Next board actions: staff said they expect to bring an architectural contract for Hill Middle School design and other bid approvals for spring/summer 2026 construction in the coming months. The facilities team proposed semiannual reporting to the board, with fall and spring updates on schedule and budget.

Quotes: Matt Shipley (facilities): "All work that we've done is rooted in that [master facility] document." Peter Kean (construction manager): "We will create a project dashboard ... a one-stop shop for the community to access through your district website."

Ending note: board members praised the communication and community engagement plans and asked staff to continue transparency on sequencing, local vendor outreach, solar feasibility and the semiannual reporting cadence.
