Conservation commission approves mill redevelopment and townhouse project, clears sewer work; several applications tabled

Loading...

AI-Generated Content: All content on this page was generated by AI to highlight key points from the meeting. For complete details and context, we recommend watching the full video. so we can fix them.

Summary

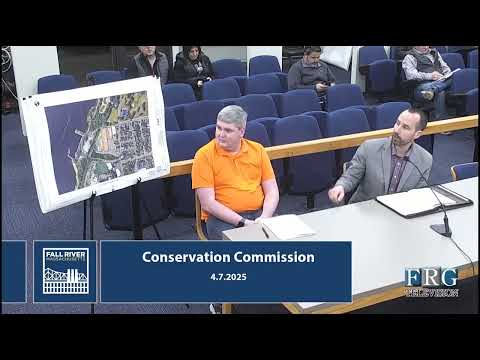

The Polaroid Conservation Commission on April 7 approved multiple permits affecting riverfront and wetland areas, including an order of conditions for a former mill redevelopment and an order for a 21‑unit townhouse project, and issued procedural rulings on city sewer and septic work.

The Polaroid Conservation Commission on April 7 issued permits and procedural rulings on multiple land‑use and resource‑area filings, including an order of conditions for the proposed redevelopment of a former mill complex, approval of a 21‑unit townhouse project subject to site plan review and federal/state stormwater permits, and a negative determination for a city sewer upgrade project. The commission also approved a proposed septic repair conditioned on Board of Health approval and selected an outside consultant to perform a resource‑area delineation review.

Why it matters: The approved projects affect waterfront and riverfront areas, stormwater management in older industrial corridors and neighborhoods, and sewer infrastructure capacity for future development. The commission’s conditions emphasize site plan review, state water‑quality permitting and restoration of disturbed wetland areas.

The commission opened, discussed and acted on multiple agenda items. Key outcomes included:

• Mill complex redevelopment (Tentative file 24‑844): The applicant (represented by Carlos Sculte of Civil & Environmental Consultants) described a proposal to rehabilitate historic mill buildings along the Taunton River, add roughly 190 housing units, about 2,222 parking spaces and about 2,900 square feet of frontage commercial space, and to improve on‑site stormwater controls and riverfront vegetation. The commission voted to issue an Order of Conditions with the commission’s standard conditions; the applicant committed to additional record‑keeping and to cleaning debris from the wetland area behind the site.

• South Beacon Street — townhouse project (file 24‑852): Northeast Engineering presented a revised plan to build seven triplex buildings (21 units) on the west side of South Beacon Street with a revised drainage approach that reduces impervious cover compared with a previously permitted self‑storage plan. The commission voted to issue an Order of Conditions with two explicit pre‑construction conditions: (1) no work to begin until site plan review is satisfactorily completed, and (2) no work to begin until a copy of any required NPDES permit (or other MassDEP water‑quality authorization) is provided to the commission. The plan relies on infiltration (KulTek) for rooftop runoff and a sediment removal basin plus a level spreader for parking lot runoff.

• North End Interceptor Sewer Improvements (City of Fall River): LEC Environmental Consultants presented phase‑1b of a sewer interceptor upgrade that replaces a 12‑inch sewer main with an 18‑inch main in sections that cross mapped wetlands and a perennial stream (Mother’s Brook). The commission reviewed temporary impacts, erosion‑control, and restoration measures; it voted to issue a negative determination (temporary impacts only, with required restoration and permitting through MassDEP if required). The applicant noted the project will seek MassDEP water‑quality certification and, if required, will supply monitoring or reporting.

• Septic repair at 440 Captain Circle (file 24‑850): The commission reviewed a proposed repair using an advanced treatment / sand filter system sited within the 100‑foot buffer of a bordering vegetated wetland. Staff reported the Board of Health (Title 5) will also have to approve the system; the commission voted to issue an Order of Conditions conditional on Board of Health approval.

• Resource‑area delineation contract (ANRAD, 1 Shaw Street, file 24‑851): The commission accepted the proposal from Ecosystem Solutions (Brandon Fannin) to perform an independent review of bordering vegetated wetland boundaries on a degraded waterfront parcel north of Middle Street.

What was tabled or continued: multiple items were continued to future meetings at applicants’ request or for additional information, including a proposed in‑ground pool at 565 Detroit Street (file 24‑840), a single‑family dwelling at 121 Whitfield Street (file 24‑847), several enforcement and compliance certificate requests, and other hearings that need additional materials or DEP coordination.

Votes at a glance (file → outcome / conditions): • Tent. 24‑844 (Omar Ifca mill redevelopment) — Order of Conditions issued (standard conditions; cleanup/mitigation and record‑keeping required). • 24‑852 (South Beacon Street, African High Development LLC) — Order of Conditions issued; work prohibited to begin until site plan review complete and until applicant provides any required NPDES/MassDEP permit. • North End Interceptor (City of Fall River; request for determination) — Negative determination/termination issued for temporary impacts with restoration and MassDEP coordination as required. • 24‑850 (Antoine Medeiros, 440 Captain Circle) — Order of Conditions issued, conditional on Board of Health/Title 5 approval of the proposed advanced septic system. • 24‑851 (1 Shaw Street ANRAD) — Consultant for resource delineation contracted (Ecosystem Solutions). • Multiple items tabled to next meeting: 24‑840 (565 Detroit St pool), 24‑847 (121 Whitfield St single home), Weaver Cove after‑the‑fact restoration (file not opened; DEP deficiency), Blunt Fine Seafoods certificates (24‑661/24‑803), Hayfield Lane enforcement response (file pending), and the commission’s fee structure discussion.

Discussion highlights and staff directions: Commissioners and staff pressed applicants on stormwater controls, the extent of wetland and riverfront areas, and coordination with the City engineering/planning departments and MassDEP. For the mill and townhouse projects, applicants agreed to additional cleanup and record‑keeping and to design revisions if required by engineering/site‑plan review. For the sewer project, the city team confirmed plans for temporary access, dewatering and regrading to pre‑existing contours after construction.

Meeting context: the meeting ran roughly 65–70 minutes; items ranged from short procedural tablings to multi‑speaker project presentations. The commission repeatedly emphasized that approvals often require parallel reviews (site plan review, Board of Health, and MassDEP water‑quality certification) before on‑the‑ground work can begin.

The commission set continued hearing dates and closed the session after final roll calls and the approval of minutes.
