Naples reports roughly $41 million in hurricane costs; supplemental appropriation, FEMA claims still pending

3752849 · May 19, 2025
AI-Generated Content: All content on this page was generated by AI to highlight key points from the meeting. For complete details and context, we recommend watching the full video. so we can fix them.

Summary

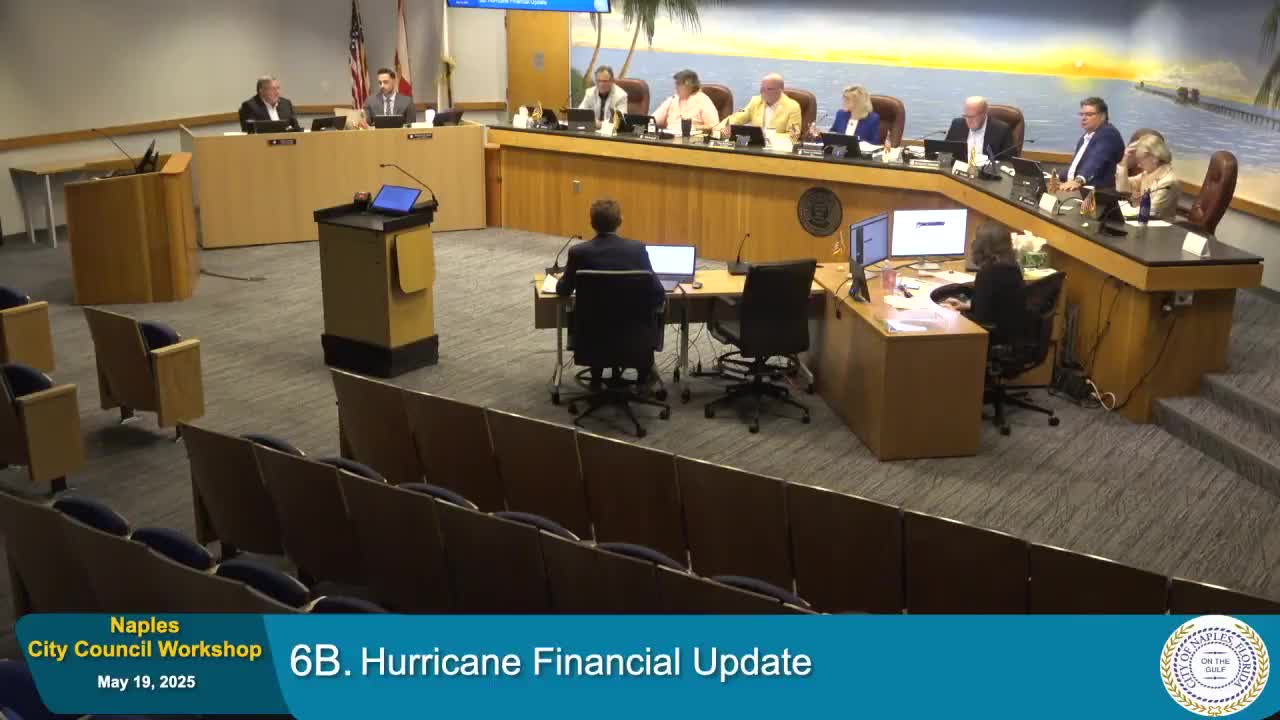

Interim finance director Stefan Masal told the council that post‑Ian recovery obligations and projects — led by Naples Pier repairs and beach access work — are driving multi‑million dollar costs. Council was briefed on insurance, FEMA and other funding sources and told to expect a supplemental appropriation on consent.

Interim finance director Stefan Masal told the Naples City Council the city’s post‑hurricane recovery work continues and city staff are still finalizing estimates and grants for Hurricane Ian and subsequent storms Helene and Milton.

At the workshop Masal described the largest budget pressure as work in the beach fund, where reconstruction of Naples Pier and beach access repairs make up the bulk of storm damages. Masal said initial project estimates put Naples Pier and associated reconstruction at roughly $26.2 million before contingency, with additional beach access and seawall work increasing the storm‑related obligations across funds; council members later cited a total of roughly $41.5 million of storm‑related obligations shown in staff materials. He said the city has received about $4.2 million in insurance proceeds to date and that FEMA obligations remain preliminary.

Why it matters: the pier is a major city asset, and the combined municipal cost of cleanup and reconstruction can affect the city’s beach fund balance and borrowing plans. Masal told council that the city had already planned an $11 million borrowing for the pier and CRA garage earlier this year and that other outside funding commitments are in place, including possible state and tourism council support.

Key numbers and funding sources (staff estimates cited to council): - Estimated storm obligations by fund total in the low‑to‑mid tens of millions; a slide shown to council summarized roughly $41.5 million in obligations across funds (staff cautioned numbers remain preliminary). - Insurance proceeds received to date: about $4.2 million. - FEMA: Masal said FEMA is still performing obligations review; staff used a preliminary assumption that FEMA might reimburse roughly $7 million related to the Naples Pier, with FEMA eligible amounts still to be finalized. - Other pledged sources: Collier County Tourist Development Council (TDC) roughly $2.2 million toward the pier, state appropriations cited by staff of about $5 million, private donations approximated at $1.5 million, and an $11 million debt issuance already authorized for the beach projects and CRA parking garage that will help preserve fund balance while work proceeds.

Supplemental appropriation and timing: Masal told council a supplemental appropriation will be prepared for consent to cover remaining project commitments and ongoing recovery costs; he said a separate supplemental to cover Hurricane Helene and Milton expenses (relatively small compared with Ian) would also be presented. Staff estimated net city share after projected reimbursements and grants could decline as FEMA obligations are finalized; in an exchange with council, Masal said that of roughly $41.5 million in obligations, outside grants and insurance could reduce the city’s net out‑of‑pocket exposure to approximately $16.4 million (a preliminary staff figure that depended on grant and FEMA obligations).

FEMA and insurance process: Masal explained FEMA is the insurer of last resort and typically reviews the city’s insurance coverage before obligating assistance; FEMA also does not pay for lost landscaping and will not pay for work that is not cost‑effective mitigation. Insurance reimbursements are paid at actual cash value for equipment and vehicles; the city reported two fire trucks with damages, of which insurance proceeds offset part of the replacement cost. Masal warned FEMA obligations are still preliminary and may change as FEMA completes its reviews.

Nut graf: Council was briefed on the scale of recovery work — especially pier and beach access reconstruction — and told staff would return with a supplemental appropriation to authorize work already underway and to maintain appropriate fund balance while FEMA and other reimbursements are resolved.

Background and next steps: Masal reviewed the difference between insurance proceeds, FEMA public assistance and other grants; he said staff anticipate FEMA obligations to arrive in stages and that the city will continue to track costs and possible mitigations. Councilmembers asked questions about grant timing, TDC application status and the pier project financing. Masal and the city manager said staff would continue to refine estimates and present the supplemental appropriation in a coming consent agenda item.

Ending: Staff characterized the current numbers as preliminary and urged council to treat FEMA obligations and final insurance settlements as evolving; the council directed staff to bring back supplemental appropriation language and to continue working with state, county and grant partners to reduce net city costs.
