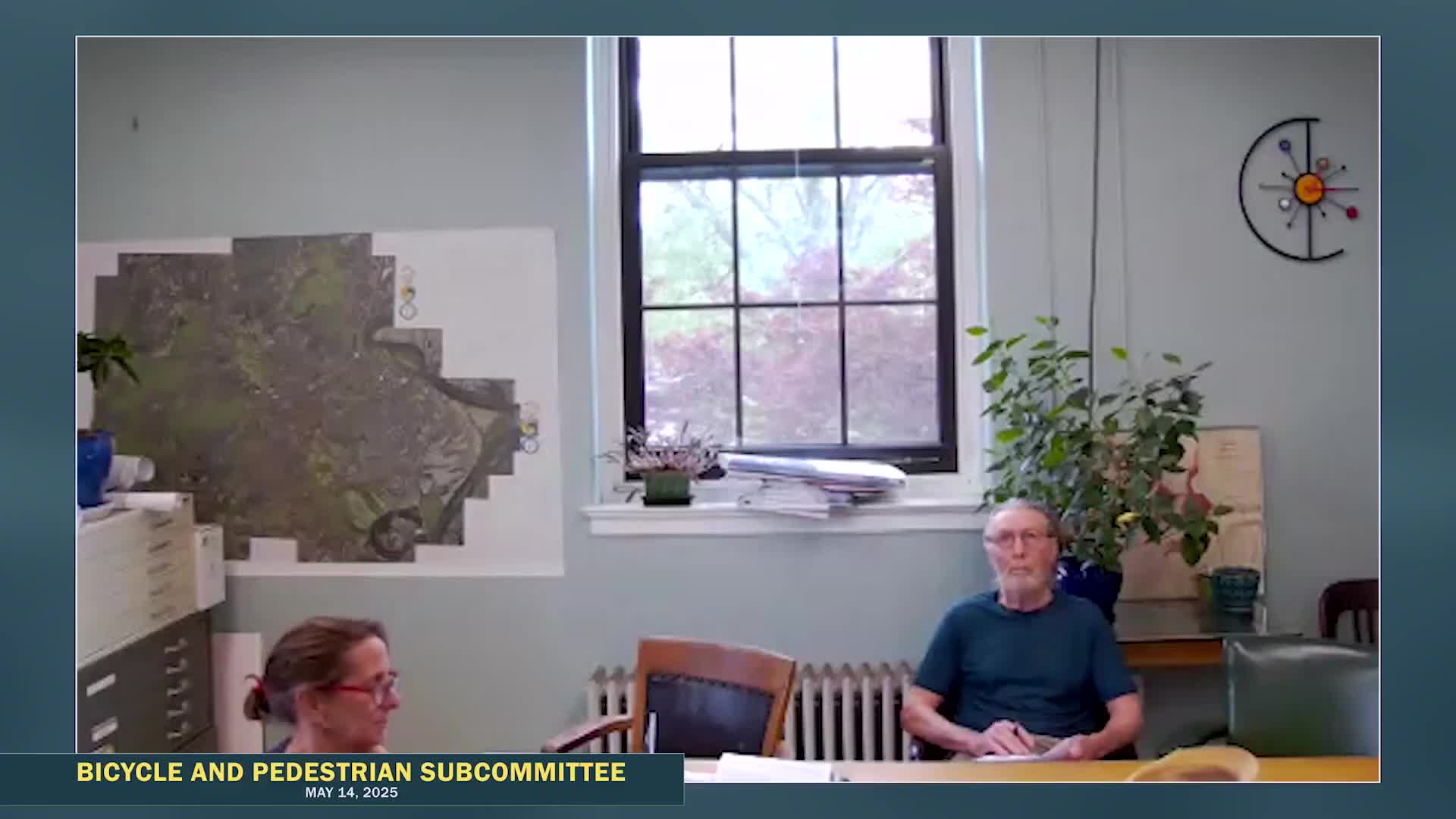

Northampton planning and public works staff told the Bicycle & Pedestrian Committee on May 14 that the city expects substantial pavement and sidewalk work this summer but that staffing shortages and utility conflicts will delay some tasks and affect routine services such as street sweeping.
The report matters because the work affects bicycle lanes, sidewalks and neighborhood travel: residents and cyclists depend on clear shoulders and repaired pavement for safety, and some local streets are closed temporarily because culverts were overwhelmed by recent storms.
Donna Ascalia, Department of Public Works staff, said the city has “a slug of projects in the pipeline” and that officials requested funding to pave more than 20 streets. She said about half of the announced paving is likely to go out to bid in the next couple of weeks, but several projects face utility conflicts with Eversource or other companies that must finish work before paving can occur. “We also have a pretty large sidewalk reconstruction project,” Ascalia said, listing portions of State Street, both sides of Bedford Terrace, Route 9 from Cooley Dickinson Hospital to the high school, and a section of Florence Road from Ryan Road to Florence Heights.
Ascalia said the gas company will mobilize a paving contractor within about two months to restore trenches left by last year’s work, primarily in Ward 3. She added the Public Works office is understaffed: “I have, I I'm missing about 30% of my workforce. So, you know, everything we're doing is delayed,” and said that routine tasks such as street sweeping are being bumped in order to address safety issues like large potholes, sinkholes and utility problems.
Planning staff gave committee members an update on multimodal projects. The office confirmed a preconstruction meeting for Rocky Hill Greenway Phase 1 will be held Friday and said the earliest field work will be tree removal on Route 66 before crews move into off-road sections. Planning staff said that work should be visible during the summer and that the project team expects contractors to mobilize shortly after the preconstruction meeting.
The staff update also noted that the Massachusetts Department of Transportation (MassDOT) is nearing construction design completion for the shared-use path on Mount Tom Road; MassDOT sets that project’s schedule independently, and construction likely will not start until the following year.
Recent heavy rains have overwhelmed culverts in several locations, forcing temporary street closures. Planning staff said Old Wilson Road, near the Pinegrove Golf Course, was closed to through traffic after a culvert failed. The planning staff described a potential long-term response under consideration: converting Old Wilson Road to a pedestrian-and-bicycle access with parking and a pedestrian connection over the stream, but said the closure and any permanent change are running ahead of previously planned design schedules and that no final decision has been made.
A member of the public, David Rosenmiller, raised procedural questions during the public comment period about the timing of posted minutes and about scheduling of pothole paving and street sweeping near bike lanes. The committee chair (name not provided in the transcript) responded that minutes are posted only after committee adoption and that Northampton Open Media records and archives meetings.
Gary Langley, introduced himself as a recent addition to the FNT board of directors and said he will serve as the FNT liaison to the subcommittee. There were no motions or votes related to the paving, greenway or road-closure matters; the only formal action on the agenda was a routine motion to adjourn, which passed on a roll call.
Committee members and staff said they will provide timing updates as bid packages and utility restorations proceed; no dates for construction start beyond the Rocky Hill preconstruction meeting were provided.
For cyclists and pedestrians, the immediate implications are practical: planned paving and sidewalk reconstructions could improve conditions on Route 9 and State Street but schedule and sequencing depend on utility work and staffing. Street sweeping and minor repairs may be delayed until Public Works fills vacancies or reallocates crews.
