Regional School District 15 board authorizes up to $85,000 to replace failing Longmeadow Elementary playground section
Summary
After months of inspection and vendor estimates, the Regional School District 15 Board of Education approved up to $85,000 to replace a failing front section of the Longmeadow Elementary School playground, prioritizing operating funds and PTO contributions before drawing on capital reserves.
Get email alerts on the School Playground topic
No spam. Unsubscribe anytime.

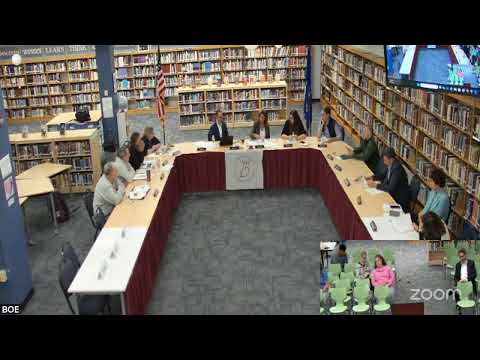

The Regional School District 15 Board of Education on Sept. 8 authorized up to $85,000 to replace the front section of the Longmeadow Elementary School (LMES) playground after school staff and vendors determined repairs to the aging equipment were not cost-effective.
District staff presented a months-long review that began in January when a tall slide at LMES showed signs of bracket failure and general structural aging. The superintendent explained the district initially sought repair estimates and learned the specific replacement parts were no longer manufactured, which pushed the district to consider replacing the failing 30-year-old structure rather than repeatedly repairing it. The board received two vendor approaches: Ben Shaffer Recreation (on the Connecticut state bid list) provided a schematic and a working estimate of roughly $75,000–$85,000 for replacing the front section; a second vendor proposed a seasonal-discount match but had not yet submitted a formal quote.
Why the decision mattered: board members said the playground serves large daily groups of students (the superintendent noted the site can see 100–150 students at a time) and that the structure posed a growing liability risk for unsupervised periods. District presenters described the remaining rear sections as safe and salvageable and said staff removed hazardous pieces and covered the area with fresh mulch before school opened.
Board debate centered on three financing options presented by district staff: require the LMES PTO to fundraise for the replacement (a model used by some schools in the district in prior years), transfer funds from district capital reserves, or include a replacement in next year’s operating capital budget. Superintendent Smith said, “we have a capital reserve for a reason,” but also told the board he did not view the situation as an emergency that required bypassing the board. Several board members pressed for a faster timeline, citing student use and safety concerns. One board member said the district should not rely on PTOs to fund structural replacements; another expressed concern about depleting capital reserves that were built for larger, potentially catastrophic repairs such as HVAC failures.
The board also discussed product design and longevity: some members urged exploring modular, standalone components that can be repaired individually instead of large interlocking structures, and others emphasized accessibility and equity across all elementary schools. District staff said modular and universally-accessible equipment would likely raise costs substantially but agreed to obtain additional pricing and model options.
On timing, district staff estimated roughly an eight- to ten-week lead time after order placement and additional weeks on-site for contractor scheduling and installation; a vendor representative present said installation could be scheduled in about six weeks to place equipment on-site and a total of around ten weeks for a completed installation, depending on contractor availability and weather.
Formal action and outcome: The board approved a motion (as amended) authorizing up to $85,000 for the LMES playground replacement with a stated funding priority: (1) use available operating capital first, (2) accept contributions from the LMES PTO, and (3) cover any remaining balance from the capital reserve. The motion was approved by roll call vote.
Votes at a glance: - Transfer to replace LMES playground: Motion approved (amended) to authorize up to $85,000, priority funding from operating capital, then PTO contributions, then capital reserve for any balance. (Mover: Sally; Second: Shannon Cavallo; final motion amended by John and seconded by Heather Rogers; approved by roll call.) - Other routine votes taken during the meeting: approval of minutes for 06/08/2025 (approved), meeting dates for 2026 (approved), and Board goals for 2025–26 as amended to add the GES/PES building projects to the facilities/capital section (approved). These routine votes appear in the meeting minutes and were handled during the business section.
What happens next: District staff said they will request the remaining vendor quote, pursue additional modular and accessibility pricing, and attempt to identify operating-budget sources to reduce the amount drawn from capital reserves. Staff also committed to report back to the board with final quotes, an installation schedule, and any matching or PTO contributions. Several board members asked staff to develop a policy or clearer process for how the district will handle playground replacements and similar facility needs in the future to avoid ad hoc decisions.
The board moved the playground item into the regular business requiring action so the public could comment before the vote; members of the LMES PTO and community spoke during public comment urging district support and offering to help fundraise. The board’s approved motion enables work to proceed while staff finalize vendor details and funding allocations.
