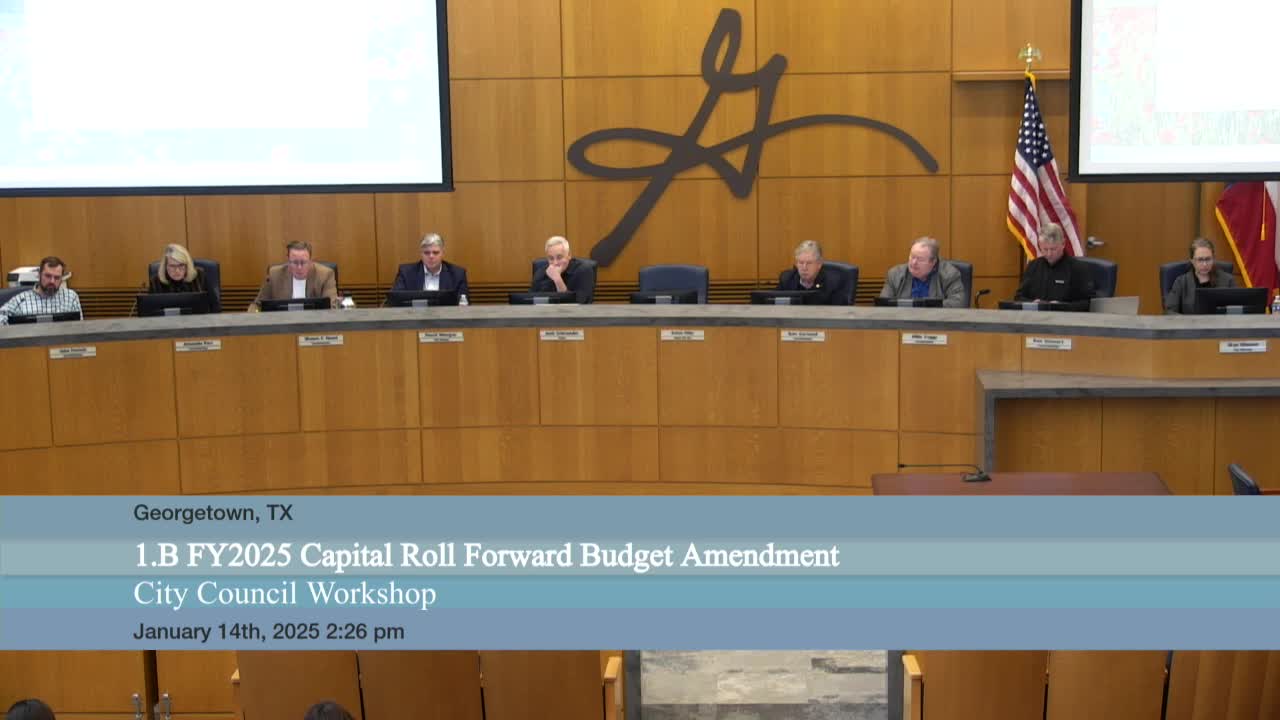

Get Full Government Meeting Transcripts, Videos, & Alerts Forever!

Council briefed on $612 million CIP roll forward; operational roll forwards total about $16 million

January 14, 2025 | Georgetown, Williamson County, Texas


This article was created by AI summarizing key points discussed. AI makes mistakes, so for full details and context, please refer to the video of the full meeting. Please report any errors so we can fix them. Report an error »

Council briefed on $612 million CIP roll forward; operational roll forwards total about $16 million
Budget Manager Myra Cantu told the City of Georgetown City Council that the proposed CIP roll-forward budget amendment carries roughly $612,000,000 of capital project budgets into FY2025 and includes about $8,700,000 of interest appropriations.

Cantu said operational roll-forwards total approximately $16,000,000, with the largest single operational item in water at about $7,400,000. She provided a list of large capital projects to be carried forward and explained the roll-forward process, which preserves budget authority for multi-year projects when expenses are not fully incurred in the originally budgeted year.

Cantu described how the roll-forward works: if a multi-year project had unspent budget authority at year end, that unused portion moves into the next fiscal year so the project can be completed. She said a full list of projects is included in Exhibit B of the amendment materials.

She identified several major capital projects included in the roll forward: the South Lake Water Treatment Plant, Berry Creek Interceptor, the St. Gabriel Wastewater Treatment Plant rehabilitation, DB Woods, Shell Road and the Downtown Parking Garage. Cantu said the operational roll-forward items include fire capital expenditures ($246,000), a marketing/Ask GTX item ($50,000), a land purchase for future municipal facilities (about $801,000), and ongoing clean-up and reclassification of the solid waste fund leading to a $17,000,000 roll-forward in that fund.

Cantu listed IT and equipment items included in the roll-forward: two electric bucket trucks and additional Ford F-150 trucks for water, $300,000 to expand fiber to Ronald Reagan, a $200,000 Windows servicing license upgrade, $100,000 for a streetlight audit, $100,000 for an advanced metering infrastructure (AMI) needs assessment, and $19,000 for a specific staff training that was not held in 2024. She said the water operational roll-forward largely funds a packaged plant needed while wastewater rehabs proceed and that the solid waste fund reclassification was a timing/cleanup item.

Cantu told council the ordinance for the roll forward will have a first reading that evening and a second reading scheduled for January 28. She said a mid-year amendment is likely in May to capture any changes that arise before the mid-year review.

Council did not take formal action during the workshop; staff said the item would proceed through the ordinance readings and then the mid‑year process.
