Liaisons and auditors brief committee on transit projects, paving closeout, public-health projects and recent bond financings
Summary
Liaison reports covered transit project statuses (Fillmore extension, 19th Ave transit project, Van Ness BRT claims resolved), paving bond near-complete with ~$2.6M remaining, public health bond updates reporting ~$293M expended and encumbrances of ~$45.7M, and public finance reported recent refunding that produced net-present-value savings and several expected issuances.
Get email alerts on the Bond Programs And Audits topic
No spam. Unsubscribe anytime.
Committee liaisons and the controllers audit and public finance staff provided a multi-part briefing on bond-program delivery and oversight.

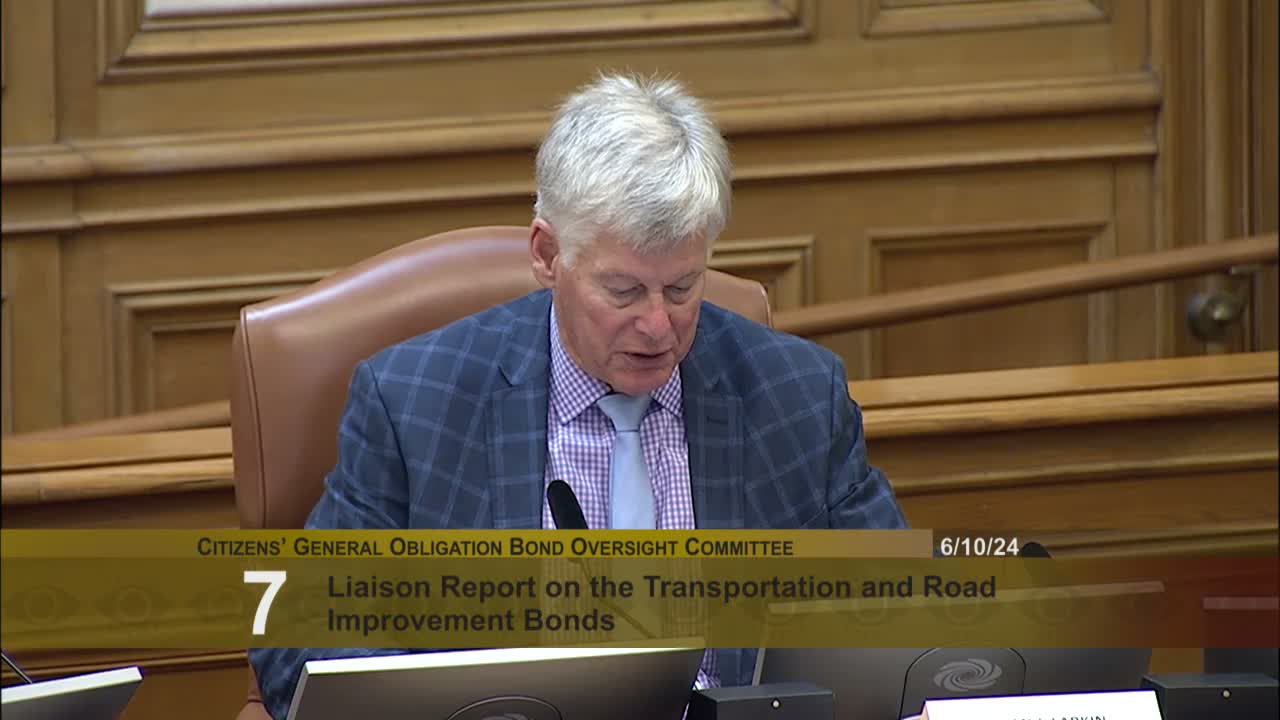

Transit liaison notes: the 22 Fillmore extension to Mission Bay is substantially complete; the 28 Nineteenth Avenue Transit Priority project is about 99% complete; BART canopy work has been delayed by security and material-delivery issues; King Street Station modifications are in closeout with an outstanding change order under review; Van Ness BRT subcontractor claims were approved by the MTA Board and will be paid.
Paving and street safety bond: liaison reported the program has been largely encumbered/spent (about 98–99%) and only approximately $2,600,000 remains; the program is expected to be wrapped up.
Public Health & Safety bond: liaison reported program-wide expenditures of about $293,000,000 with encumbrances of roughly $45,700,000, representing about 95% of appropriations and 97% of the program budget. Several active projects remain at Zuckerberg Building 5 (dialysis relocation, seismic upgrades, public-health lab, psychiatric emergency services), with staggered completion targets through 2025.
Audits and public finance: Mark Dela Rosa from the controllers office summarized recent public integrity reporting (including a March 2024 report about SFPUC procurement with two findings and three recommendations) and said a four-year review of recommendation implementation is in progress. Vishal Triadhi in public finance summarized a recent refunding and defeasance transaction that staff reported yielded net present value savings and previewed planned issuances (a seawall bond ~ $120,000,000, a third issuance for a 2020 bond ~ $150,000,000, the remainder of the 2019 affordable housing authorization ~ $174.6 million, and an initial $30,000,000 issuance for the recently passed March affordable housing bond).
