Clay County budget workshop: staff seeks $10M in reductions, recommends keeping millage at 8.601
Summary
County staff told commissioners a balanced budget depends on finding about $10 million in cuts or new revenue; they recommended setting the maximum millage at the existing 8.601 rate while the board reviews department projects, CIP and ARPA options tonight.
Get email alerts on the County Budget topic
No spam. Unsubscribe anytime.
County staff presented a proposed fiscal plan that would hold the county's millage at the current rate of 8.601 but still leaves a roughly $10 million shortfall that must be found through project deferrals, scope reductions or new revenue.

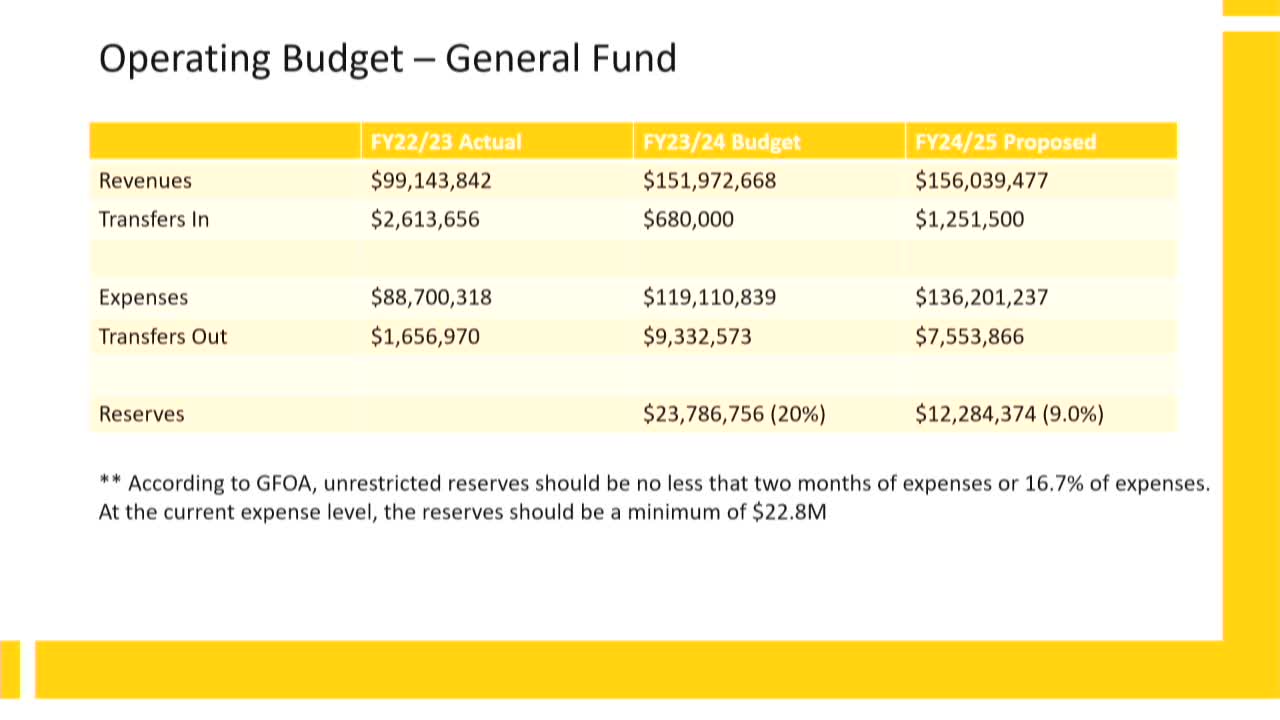

Troy Nagel, county staff lead on the presentation, said General Fund revenues are projected at about $156 million with expenses near $136 million and reserves of roughly $12 million. That reserve level is well below the Government Finance Officers Association guidance of 16.7 percent; staff calculated Clay County's reserves at about 9 percent. "We do need to find about another 10,000,000 of either reductions in the budget or revenue," Nagel said.
Staff outlined steps already taken: moving certain costs to project-based lines, trimming operating estimates to historical spend levels, reviewing new position requests and proposing a smaller package of 22.5 net new FTEs (15 firefighters and 7.5 other positions) compared with earlier departmental asks.
The presentation stressed project-based budgeting for items above $20,000 so the county can better track capital and operational projects separately. Staff also recommended moving telecom and software lines into IT to comply with a Florida statute on procurement and to centralize invoicing.
On reserves and timing, staff said they expect Department of Revenue (DOR) data later in the summer and projected only a modest increase from state estimates; they cautioned that relying on DOR increases to close all gaps would be imprudent. The county manager's office asked commissioners to identify proposed projects to defer or scope down during the workshop and subsequent meetings.
The board was asked to set the maximum millage at tonight's meeting and to schedule final budget hearings for Sept. 10 and Sept. 24. The workshop closed with staff standing by to supply more detailed backup (vehicle replacement lists, line-item project lists, and updated revenue estimates) requested by commissioners.
The county will next discuss firm project reductions and potential ARPA reallocation options before final budget adoption.
