Council reviews scaled‑back FY27–31 CIP; Fire Station 3, property yard and buses flagged as large items

Fairfax City Council · November 18, 2025
AI-Generated Content: All content on this page was generated by AI to highlight key points from the meeting. For complete details and context, we recommend watching the full video. so we can fix them.

Summary

Staff presented the draft FY27–31 Capital Improvement Program (~$636.7M total; ~$449M from the general fund) and highlighted a reduced set of FY27 projects plus several large-ticket items (Fire Station 3, Van Dyke master plan, property yard at an updated estimate of $155M, and six Q‑buses). Council asked about phasing, interim uses for vacated buildings, staffing capacity to deliver projects, and opportunities for alternative funding.

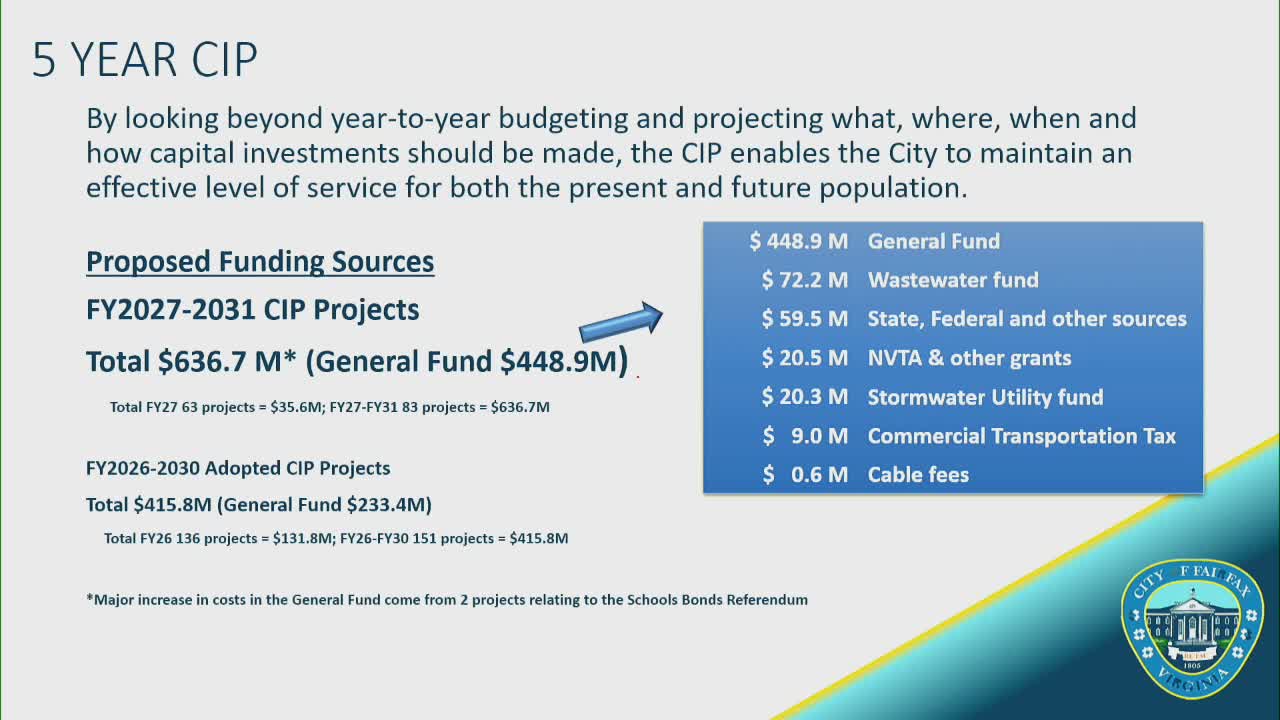

Acting city manager Melanie Zipp and finance staff presented the draft FY27–31 CIP. Staff said they tightened CIP inclusion criteria to true capital assets (useful life ≥5 years, one‑time costs above $50,000) and moved recurring repair/maintenance items back into the operating budget. The total five‑year CIP request is $636.7 million, with about $449 million estimated to come from the general fund; staff noted the increase over the prior plan was primarily driven by school bond–related projects.

Staff highlighted a small number of FY27 new projects and concentrated on three large items that will shape near‑term capital planning: Fire Station 3 (project funding began in FY24 and remains under discussion; construction anticipated in an out year pending design and consideration of a PPEA delivery method), the Van Dyke master plan (community outreach to be revisited; feasibility/design funding pushed to FY28), and the city property yard (previous rough estimate ~$65M refined to ~$155M because of options that include floodplain mitigation or splitting the yard). The city also expects to order six replacement Q‑buses in FY27 (delivery lag estimated at 18 months under DRPT rules), and noted an 18‑month wait for buses and 3–5 years for fire apparatus.

Council questions focused on interim uses for newly vacated space (the George Mason University–owned building the city recently acquired), the timing and urgency of Van Dyke improvements, the ability to preorder buses (DRPT prohibits preordering until useful life threshold), staffing capacity to manage multiple projects concurrently, and whether economic impact or ROI analyses should be incorporated into project evaluations.

What happens next: Planning commission public hearings and further budget work sessions are scheduled over December–February; staff said a GMP for the Willard Sherwood project is expected in January and that council will see updated cost information and options for major projects as those numbers are finalized.
