TIDA presents $41.7M FY27 spending proposal; board questions staffing, subsidies and park funding

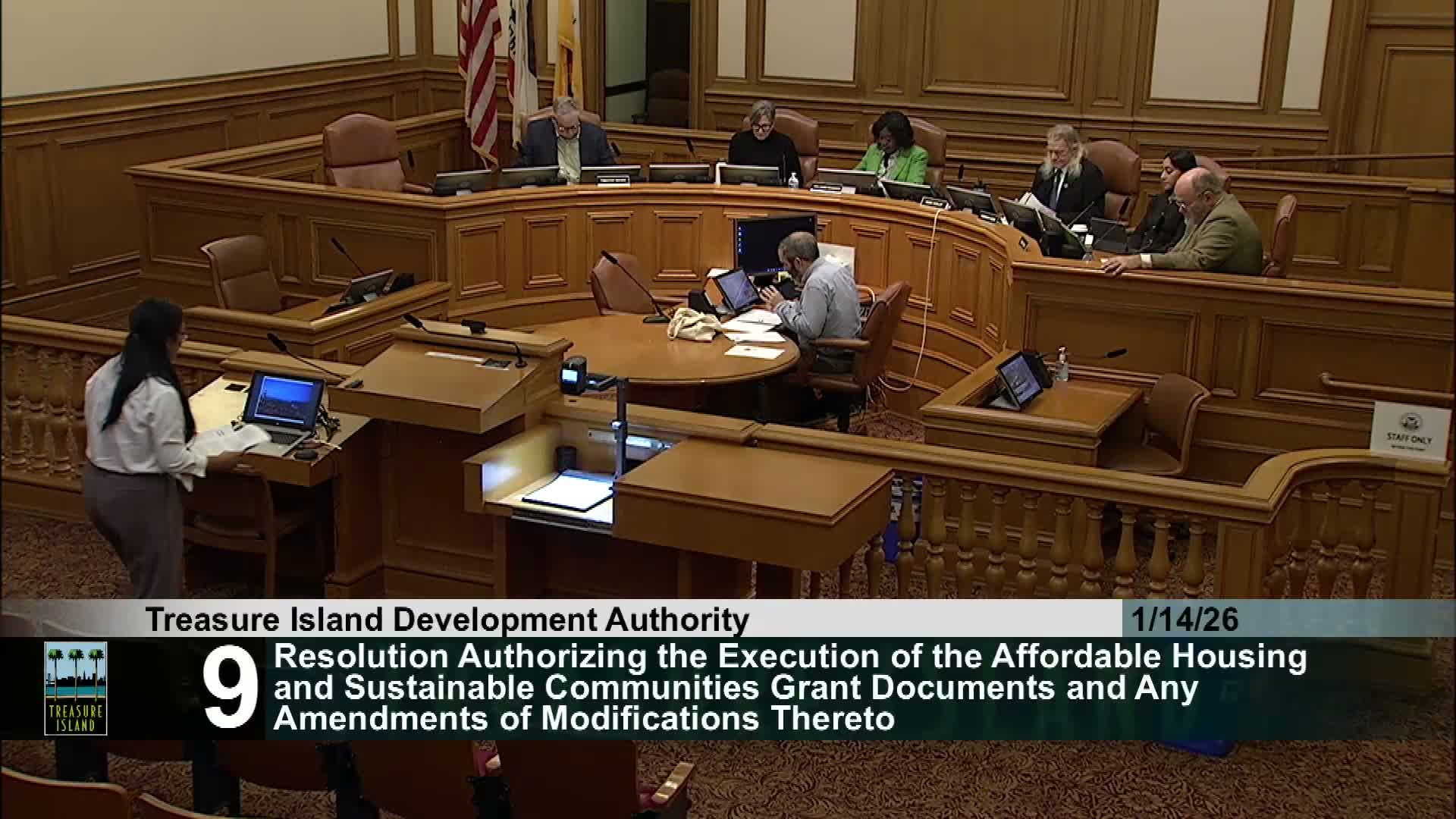

Treasure Island Development Authority Board · January 14, 2026
AI-Generated Content: All content on this page was generated by AI to highlight key points from the meeting. For complete details and context, we recommend watching the full video. so we can fix them.

Summary

TIDA staff presented a two‑year draft budget proposing about $41.7 million in FY27 across authority, city cost and subsidy budgets; commissioners asked for clarifications on staffing fills, revenue handling for events, developer housing subsidy draws, TIMA transit funding and legacy park maintenance.

TIDA finance manager Jamie Corubin presented a draft two‑year budget on Jan. 9 that proposes approximately $41.7 million in spending for fiscal year 2027, composed of an authority cost budget (~$18.0M), city cost (~$6.675M) and a subsidy budget (~$17.0M).

Corubin told the board that the FY27 authority cost increase reflects a one‑time $3 million grant awarded through the Bay Area Housing Finance Authority priority sites program and other cost drivers including COLA adjustments, increased maintenance contracts and utility costs. He said commercial and residential leasing revenues are projected to remain flat at roughly $10.7 million and that a new fund balance reserve policy would target a 10% reserve for the authority cost budget, funded over five years (about $350,000 per year).

On the subsidy side, staff flagged proposed draws on developer housing subsidy (about $8.3M accrued) to fund construction of the Behavioral Health Building and other predevelopment work, and a $3.538M allocation to support the first full year of Rec & Park maintenance services under the approved MOU. Corubin also called out a $250,000 arts allocation ($50,000 for maintenance of new art and $200,000 for temporary installation programming) funded where eligible by CFD special taxes.

Commissioners asked detailed questions about timing for filling three staff vacancies (including an 18/22 analyst and deputy director backfill), how picnic and event revenues will be handled under city controller accounting policies, revenue flows for large ticket events (staff said large events will be administered and treated as TIDA revenue and would not flow through Rec & Park), and the interim use of transportation subsidies to support TIMA operations while tolling policy and long‑term revenues remain pending.

Staff explained a planned wind down of Rubicon’s new parks scope as Rec & Park takes over maintenance of the newly built parks, while Rubicon and Tool Works will continue in legacy maintenance roles funded in the authority cost budget. The board requested a future agenda item and staff memo that itemizes legacy parks (those not in the Rec & Park MOU) and identifies responsibilities for maintenance and potential contracting approaches.

The draft budget is scheduled to return for final approval on Feb. 11; staff said they will provide follow‑ups on the staffing timeline, legacy park list, and the financing plan for housing projects.
