Council workshops parks impact-fee options; staff recommends trimming outliers (Option 3), first reading proposed Jan. 7

Grand Junction City Council · December 15, 2025
AI-Generated Content: All content on this page was generated by AI to highlight key points from the meeting. For complete details and context, we recommend watching the full video. so we can fix them.

Summary

City staff and consultants presented three alternatives for calculating parks impact fees (baseline weighted land value ~$147,000/acre; options remove downtown parcels, central-city parcels or high/low outliers). Staff recommended Option 3 (remove outliers); council indicated informal consensus and staff scheduled a first reading for a fee ordinance on Jan. 7 with possible rebate language for applications in the pendency period.

City staff and consultants reviewed revised parks impact-fee calculations at the Dec. 15 workshop and recommended a refined option that trims extreme land-value comparables to reduce the land-cost input used in the fee model.

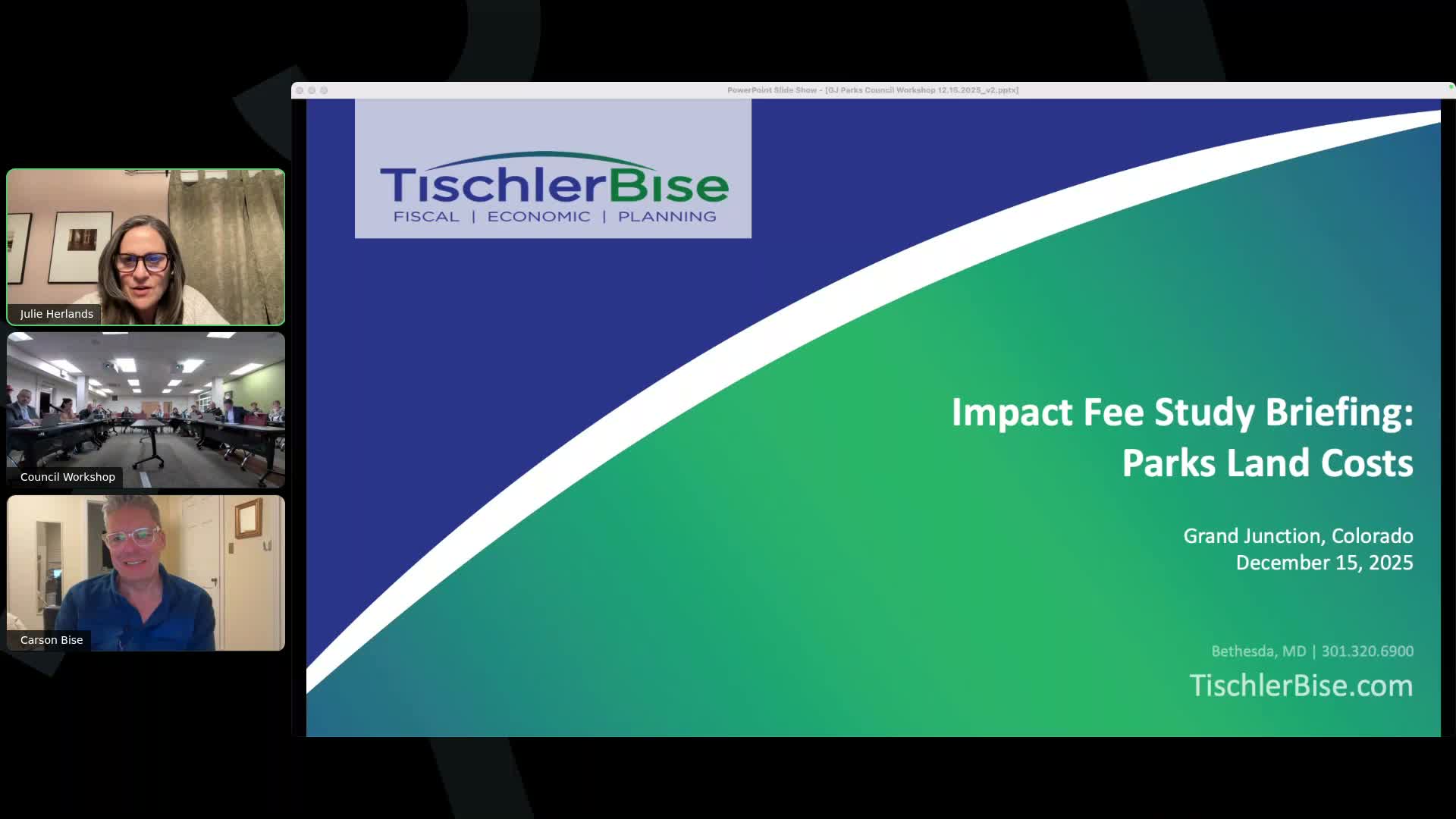

Consultant Carson (Tishler Heiss) explained the baseline study used a weighted average land sale price of about $147,000 per acre and presented three alternatives: (1) remove downtown parcels (which are disproportionately multifamily/high-value comparables), (2) remove central-city parcels, and (3) remove the three highest and three lowest sale-price outliers. Trimming outliers (Option 3) reduced the land-value input to roughly $108,000–$114,000 per acre depending on truncation and produced lower maximum-supportable fee schedules across unit-size bands.

Council questioned methodology, the study’s policy goal (maintain current level of service vs. a targeted budget), and the affordability impacts. Legal counsel (Jeremiah) explained that the study produces a "maximum legally defensible" fee tied to the city’s current level-of-service calculations but that the council may consciously adopt a lower fraction of that maximum (for example 70%) as a policy decision and remain defensible if that choice is supported by the methodology and rationale.

Jeremiah and staff also outlined procedural options for timing: an emergency ordinance could be adopted immediately but requires unanimity; a regular ordinance could be introduced at first reading Jan. 7 and include rebate language for fees collected during the ordinance pendency. Staff recommended Option 3 following committee feedback and the council expressed informal consensus to move forward; staff will prepare an ordinance for the Jan. 7 first reading and public notice.

Council members discussed incentives and credits for developers that dedicate public parkland within subdivisions (example: Redlands 360 credits/IGA) and noted that credits already exist for qualifying public-park improvements. Council and staff also discussed review intervals for future fee studies (existing code ties review to six- and eight-year touchpoints) and staff recommended retaining review discretion rather than an automatic consultant-mandated schedule.

Next steps: staff to prepare ordinance materials for first reading Jan. 7 (with potential rebate language), publish public notices, and continue outreach to the home-builders association and other stakeholders.
