Sarasota commissioners approve voluntary buyouts, direct $15.7M in Hurricane Ian funds for housing and infrastructure

Sarasota County Board of County Commissioners · July 9, 2025
AI-Generated Content: All content on this page was generated by AI to highlight key points from the meeting. For complete details and context, we recommend watching the full video. so we can fix them.

Summary

The Sarasota County Board approved three voluntary homeowner buyouts tied to Hurricane Ian, cleared roughly $15.7 million of CDBG-DR funding for reallocation and directed staff to pursue a mix of affordable housing top-ups and infrastructure projects after a commissioner-led prioritization.

Sarasota County commissioners on July 9 approved three voluntary buyouts of homeowner properties damaged by Hurricane Ian and directed staff to reallocate approximately $15.7 million in remaining federal CDBG-DR (Hurricane Ian) funds to a mix of housing, storm resilience and infrastructure projects.

The board voted unanimously to accept applications brought forward by the City of North Port (two properties) and the county (one property) for the voluntary buyout program, which is funded as part of Sarasota’s Hurricane Ian Resilient SRQ allocation and targets owner-occupied residences with a demonstrated Ian tie and a focus on low-to-moderate-income households and repetitive-loss or Myakkahatchee Creek/Hidden River areas.

Why it matters: Commissioners said buyouts remove repeatedly flood-damaged homes from hazardous locations, reduce future public costs and convert vulnerable lots to open space or stormwater-compatible uses. The board heard that two of the approved properties sit along Myakkahatchee Creek, aligning with long-standing municipal floodplain management efforts.

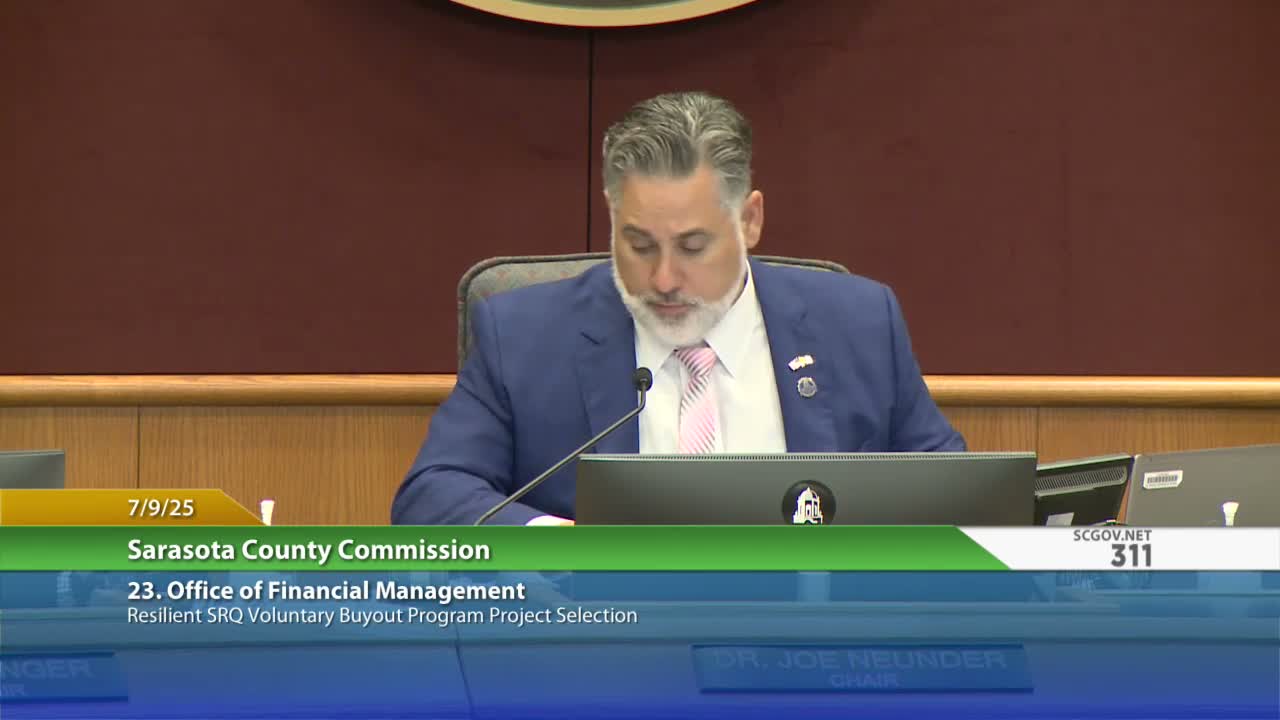

What the county approved: Steve Hyatt, program manager, told the board the three approved applications totaled about $1.2 million and that roughly $5.1 million would remain in the voluntary buyout account after those awards. Hyatt also described $15,665,950 of Hurricane Ian funding available across planning, economic recovery and other program lines for potential reallocation.

How the board decided to use the funds: Commissioners then worked through a commissioner-requested prioritization of projects drawn from previously submitted Ian-era applications. The board favored a hybrid approach—using some funding to top up a small set of previously unfunded or partially funded Ian projects (including affordable housing), while reserving staff authority to revisit funded projects’ unmet needs and, if necessary, reopen competitive applications. The board specifically agreed to a conditional top-up to Family Promise’s Parkside Village proposal and to fund or partially fund selected infrastructure and cultural projects identified during the discussion.

Allocation mechanics and next steps: Actions taken were conditional awards. Staff will execute funding agreements, verify project readiness, ensure any required matching or supplemental funding is in place, and return to the board if a project cannot meet conditions. Hyatt told the commission that partial awards would not preclude applicants from seeking additional funding under the county’s new recovery allocation if appropriate. The board asked staff to present finalized conditional agreements and to track remaining unallocated balances.

Quotes: ‘‘We’re focusing these funds where they will reduce risk and support communities most affected by Ian,’’ said Steve Hyatt, division manager, Office of Financial Management. ‘‘Once properties are acquired they must be maintained as open space or in a compatible long-term use,’’ he added.

Outcome: Motion to approve the three voluntary buyouts and to reallocate the available Ian program funds as directed (hybrid approach, conditional awards) passed unanimously. Staff estimated approximately $5.1 million would remain specifically in the voluntary-buyout line after the three approvals; roughly $15.7 million in broader Ian funds is now subject to reallocation decisions under the board’s guidance.

What’s next: Staff will prepare conditional funding agreements, confirm final budgets and matches, and return with contract documents and any necessary cleanup actions for projects that cannot meet conditions. The board also directed staff to consider previously unfunded Ian applicants before reopening a new competitive cycle.
