Parks staff outline $10.6M Lake Pflugerville project and multimillion-dollar CIP priorities
Get AI-powered insights, summaries, and transcripts
SubscribeSummary
Parks staff presented a detailed five-year capital improvement plan that included a $10.6 million Lake Pflugerville Phase 2 design and later construction, a multi-phase Destination Play project, trail funding and an unfunded $51 million athletics complex; the discussion was ask-only and no funding decisions were made.
Pflugerville parks staff led a detailed, discuss-only review of the department's five-year capital improvement program, laying out project phasing, estimated costs and funding constraints.

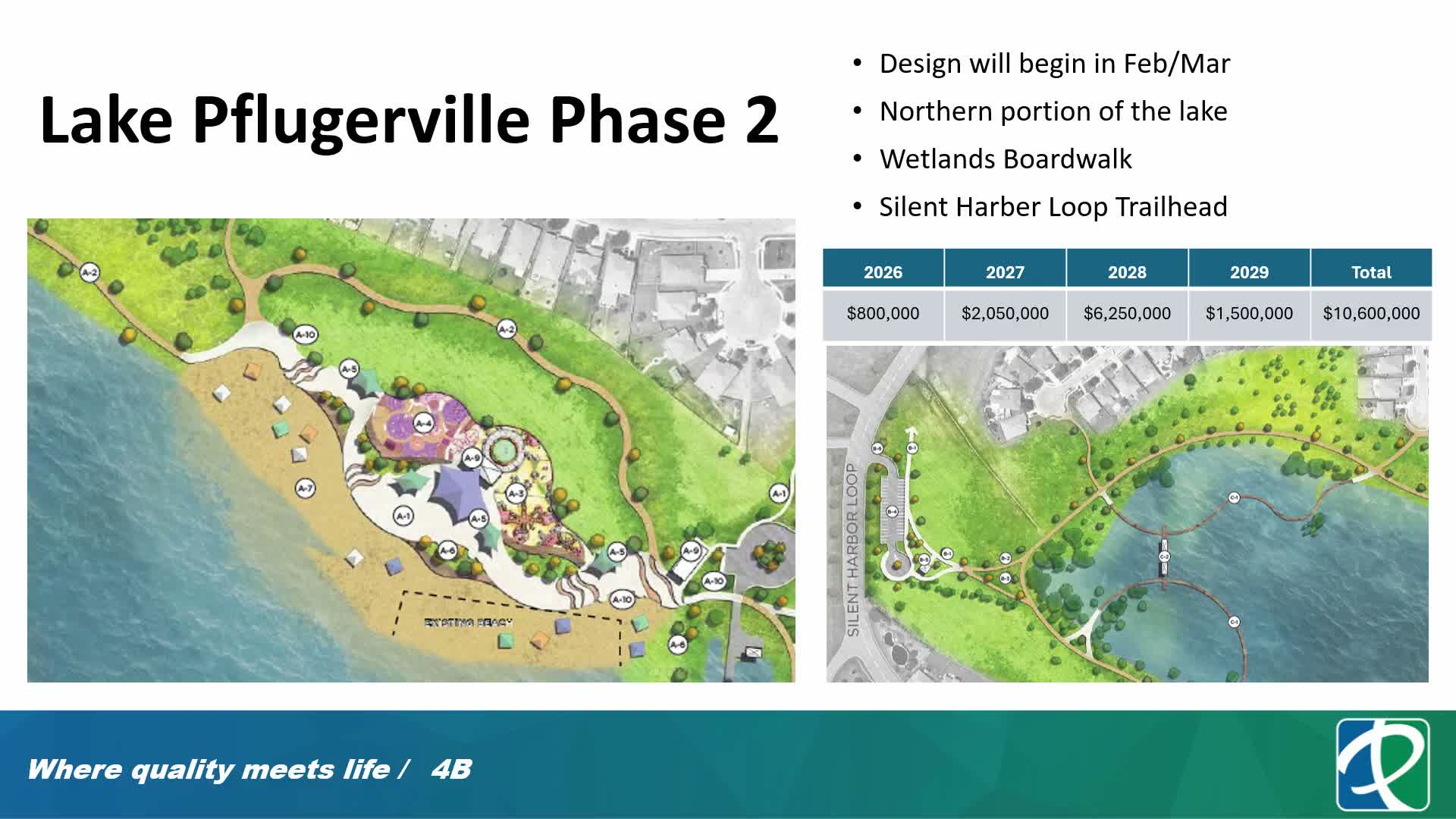

Staff told commissioners that Lake Pflugerville Phase 2 is programmed with design beginning this year and estimated at $10.6 million, with construction likely in 2027 under the current schedule. Staff said the figure incorporates inflation and that some scope elements will be refined during design and public engagement.
Destination Play was described as a multi-phase downtown project. Phase 1 is funded from the 2020 bond at $5 million; full buildout was estimated by staff at roughly $17 million, and a proposed Phase 2 ask of about $12.8 million was discussed as a future funding need. Staff characterized the project as a destination play space intended to increase regional visitation and support adjacent downtown economic activity.
Trail funding remains a steady ask: staff said the annual trail-improvements line item has averaged about $1.2 million and is intended for new trails and trail-gap connections; repair and operations are funded separately from the O&M budget. The Gillen Creek Trail Corridor master plan and targeted trail projects were highlighted as priorities to connect parks across town.
Staff also discussed longer-range and currently unfunded projects: 1849 Park Phase 3 (nature trails, interpretive areas, destination playgrounds; staff estimated ~$17.5 million), a lake nature center at Lake Pflugerville (community gardens, classroom/education space and greenhouse), and an athletic complex concept packaged in the athletic feasibility study with a high-level cost estimate near $51 million (land acquisition and four fields of several types). Staff explained that specialty facilities (for example, tournament-style athletic complexes) typically cannot be funded from parkland dedication fees under the UDC and would require other sources, such as hotel occupancy tax or bonds targeted to economic drivers.
The commission discussed phasing, procurement timing, inflation, community engagement and trade-offs (for example, whether to expand a beach area at Lake Pflugerville or to redirect funds to year-round amenities). Staff said conceptual projects remain subject to master-plan updates, public input and council decisions and that bringing projects to voters or council for bond funding adds design and engagement time.
No formal funding action was taken; staff said the plan will be refined and returned to the commission for recommendation steps tied to upcoming bond council and council processes.
