Park County commissioners postpone decision on Fish Camp rental project after safety and water concerns
Summary
On Feb. 3, 2026, Park County commissioners delayed action on an application to place six rental units on a half-acre parcel behind Fish Camp Construction after staff and emergency responders flagged narrow access, staging and well/septic isolation concerns. The applicant offered easement and testing conditions; the commission asked for written documentation before deciding.
Get email alerts on the Land Use Development topic
No spam. Unsubscribe anytime.

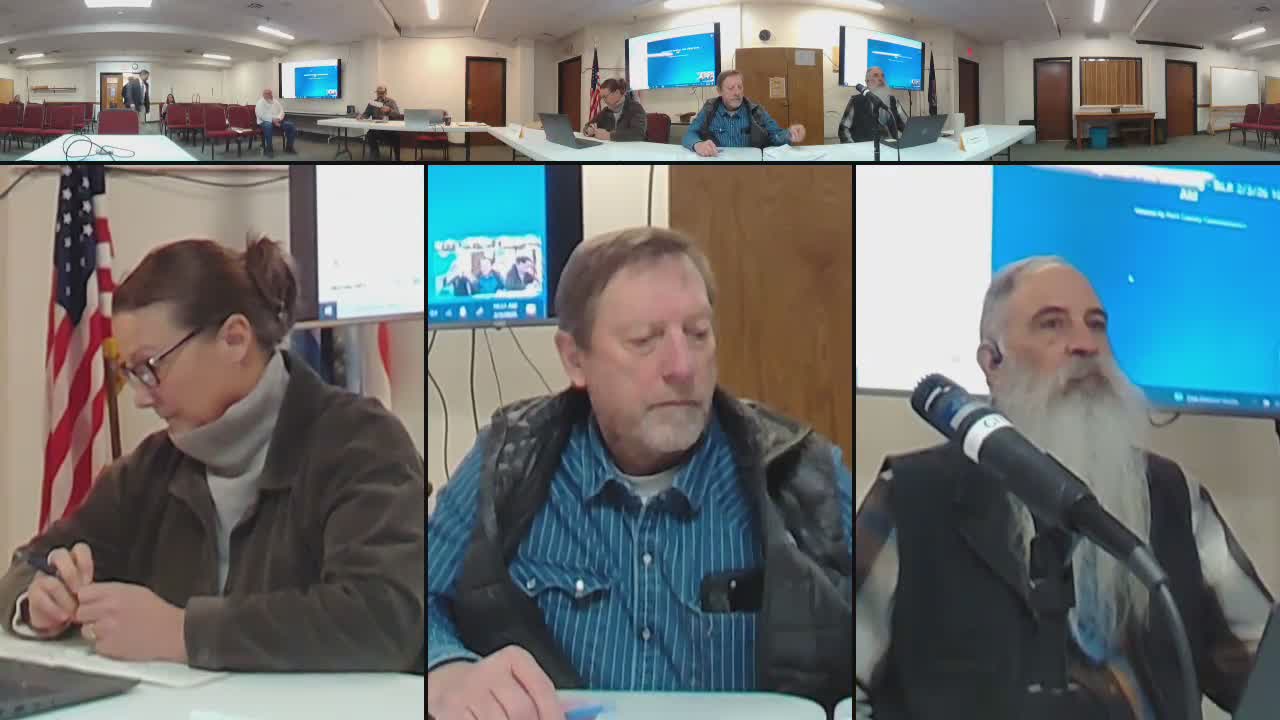

Park County commissioners on Feb. 3 debated an application to develop six dwelling units on a roughly half‑acre parcel behind the Fish Camp Construction property near Highway 89, but postponed a final decision after staff and public commenters raised fire‑access and water‑sanitation concerns.
The county planning administrator told commissioners the buildings‑for‑lease-or‑rent regulations (Title 7 model regulations) do not include design standards and require the governing body to make an adequacy determination for access, emergency response capability and sanitation. The administrator said emergency‑management feedback indicates the proposed 20‑foot access, routed through a shelterbelt, is likely too narrow for fire apparatus and lacks a staging area and engineering to guarantee safe operations. "I would recommend denial because I do not think that the proposal meets the basic level of emergency service capabilities right now, especially when it comes to fire," the administrator said.
Why it matters: Commissioners said the project touches competing county priorities — expanding housing supply in a county with limited affordable units, and protecting public health and safety where private wells and septic systems draw from shared aquifers.
Applicant and owner representatives said they can and will take specific steps if the commission conditions approval. "We're happy to take that tree out," said Steve Woodruff, the applicant's representative, when asked about widening access. Owner Jody Marler told the commission she owns both parcels and that the team can widen the easement to 24 feet, dedicate a permanent emergency‑staging easement on the Fish Camp property and commit to twice‑annual water testing for coliforms and nitrates: "We would very much appreciate getting a conditional approval, and then maybe within, say, 10 days or so, submit the language for the modified easement," Marler said.
Sanitation and groundwater concerns were prominent. County sanitation staff and the sanitarian told the commission that a previously drilled well near the property and a septic drain field on an adjacent lot may overlap the required 100‑foot well isolation zone and could pose contamination risks if not clarified and corrected. Staff recommended requiring documentation of which well will serve the new units, confirmation that well isolation zones are respected, and an operations and maintenance plan for the septic system. The administrator also noted water‑use limits tied to exempt wells and advised that the county could require a demonstration that the proposal will remain within the 10 acre‑feet per year exemption or provide other NRC/DRC documentation when appropriate.
Public comment reflected both support for more rental housing and caution about safety and enforceability. "This is the kind of housing that we're looking for in this area," said Carrie Taylor of the Park County Environmental Council, while urging that any conditions be shown in writing before an approval.
Commissioners discussed three procedural options available under state and county review timelines: deny, approve with explicit written conditions, or postpone to allow the applicant to provide the written easement language, engineering or additional documentation. The applicant volunteered to submit a revised 24‑foot access easement, a proposed perpetual staging easement on the Fish Camp parcel, a tree‑removal/limiting plan, and a schedule for water testing.
A commissioner moved to approve the application with the enumerated conditions; another commissioner proposed postponement instead so staff and emergency services could review the applicant's written submissions. The commission voted; the transcript records 'Aye' and opposed responses but does not show a full named roll call in the record. The item was postponed to allow the applicant to file the promised written easement and technical documentation and for staff review prior to a future commission meeting.
Next steps: The commission asked the applicant to submit written easement language, an emergency‑staging easement draft and water/septic clarifications within roughly 10 days, with a likely return to the commission in about three weeks (the clerk noted a possible date window). The postponement preserves the county's ability to require enforceable, written conditions before final action.
Notes: All quotes and factual points above are taken from the Feb. 3, 2026 Park County commission meeting transcript. The commission discussed Title 7 regulations, 100‑foot well isolation rules, a 10 acre‑feet per year exempt well limit, and NRC/DRC notice procedures during the meeting; where the transcript used shorthand ("NRC"/"DRC"), the article reports those references only as they were spoken.
