Montgomery County committee reviews recreation CIP, accepts staff recommendations
Loading...
Summary
The Planning, Housing and Parks joint committee reviewed 11 recreation capital projects — from pool refurbishments to a proposed North Potomac grass field — and accepted council staff recommendations without objection after staff cautioned several cost estimates remain preliminary.

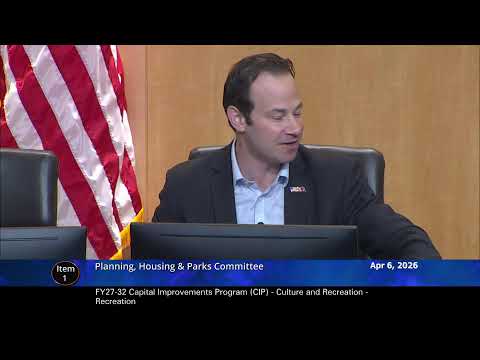

The Montgomery County Planning, Housing and Parks joint committee met to review the Recreation Department’s proposed capital improvements program and accepted staff recommendations "without objection," Chair Friedson said at the meeting's close.
At the start of the meeting the Recreation Director told the committee he was "thrilled to be back at the recreation department" and outlined a supply‑and‑demand imbalance across facilities, noting the department will update its long‑range facility plan (Vision 2030) to assess current assets and future needs. Director Dice said the county will pursue a refurbish‑first strategy—similar to recent library refresh efforts—so that cost estimates are grounded in facility analyses rather than rough guesses. "Residents of Montgomery County can anticipate modern, fresh, clean rec centers for decades to come," Dice said.
Council staff walked the committee through the packet’s 11 recreation projects. Key items included a proposed conversion at North Potomac Community Center from artificial turf to a natural grass field; staff said the $720,000 figure in the packet is a placeholder and that installing natural grass could cost as much as three times that amount, so they recommended postponing action until more accurate estimates are available. Staff also noted community testimony favored retaining synthetic turf at that location.
The committee reviewed major renovation and replacement projects across the system. The CASAC building‑envelope project (windows, new exterior masonry veneer and roof replacement) has a notice to proceed issued in July 2024 and is scheduled to finish in 2026; staff reported roughly $9,000,000 of the project has been spent through FY25 and an estimated $18,000,000 is anticipated for FY26, with the project funded largely by general obligation (GO) bonds. Staff recommended the committee approve the CASAC work as proposed.
Pool projects drew particular attention. Staff and directors warned that indoor pools are heavily used county assets that require careful sequencing; a recent walkthrough revealed unexpectedly poor pool‑floor conditions at one site, and Dice said staff will return with firm estimates and likely request additional funds to avoid reopening a facility only to close it again for follow‑up work.
Other projects discussed included the Holiday Park Senior Center facade project, presented as supporting the county’s 2035 greenhouse‑gas net‑zero goal, refurbishment placeholders across dozens of community centers (a six‑year total just over $24 million was noted for a large refurbishment program), playground replacements supported in part by state aid, and a slide‑replacement program that reflected a modest cost increase as design work advances.
Councilmember Giwanda asked how sites are prioritized and whether racial equity factors into scheduling. Council staff and directors said prioritization combines condition assessments, facility usage and equity considerations; Division Chief Adrianne Clutter described the internal CountyStat scoring matrix that factors income, vulnerable populations, remaining useful life and usage. Staff agreed they could synthesize and publish key scoring factors so the public understands why one site is scheduled before another.
Staff also noted the North Bethesda Community Recreation Center (a proposed 46,200‑square‑foot facility associated with White Flint sector plan work) remains in the CIP but has no start date; timing depends on sector‑plan implementation and affordability considerations.
By the meeting’s end the committee accepted the staff recommendations for the recreation CIP "without objection." Chair Friedson thanked both departments for their engagement before adjourning.
The committee did not record a formal roll‑call vote in the transcript; staff will return with refined cost estimates and project timing as design and facility assessments are completed.
