Chicago Public Schools officials seek public input as they outline FY27 capital priorities, cite $3 billion in critical needs

Chicago Public Schools (CPS) · April 14, 2026

Loading...

AI-Generated Content: All content on this page was generated by AI to highlight key points from the meeting. For complete details and context, we recommend watching the full video. so we can fix them.

Summary

Chicago Public Schools officials Ian Hansen and Vinny Dyer outlined 12 proposed FY27 capital budget categories, emphasized accessibility and sustainability, and urged the public to complete a spring survey (open through April 30) to help prioritize projects amid an estimated $3 billion in immediate critical needs.

Chicago Public Schools officials on a community call urged residents to weigh in on the district's FY27 capital budget as they outlined a range of project categories and described the tools the district will use to prioritize scarce funds.

Ian Hansen, identified in the meeting as the district’s chief facilities officer, opened the session and said the district’s built portfolio averages 86 years old and covers roughly 62,000,000 square feet. “Stakeholder feedback has helped us shape our capital plans in years past,” Hansen said, asking attendees to complete a spring survey that CPS said is live through April 30.

Vinny Dyer, the district’s executive director for capital planning, walked through 12 proposed FY27 capital categories that carry forward many FY26 priorities: roof and envelope work, mechanical/electrical/plumbing upgrades, restroom renovations, parking-lot and site repairs, playground and exterior improvements, student recreation and athletic resources, modular refurbishments, space-efficiency analyses, IT and security investments, programmatic classroom improvements, energy-efficiency projects and accessibility work.

Why it matters: presenters said the backlog of critical repairs is large and growing, and resources are limited. Hansen said the district’s immediate critical needs exceed $3,000,000,000, and that last year the board approved a capital plan of about $500,000,000 (excluding outside funding) while the district leveraged roughly $55,700,000 in external funds.

How projects are chosen: Dyer described a prioritization process driven by facility condition assessments, an 11-indicator opportunity (equity) index developed with the Office of Equity, available outside funding and alignment with district academic initiatives. “The opportunity index is one of 11 factors taken into consideration,” Dyer said, adding that the index incorporates community factors, school demographics and historical funding.

Accessibility and sustainability: officials said making campuses more accessible remains a priority; they described a phased ADA strategy that first aims to make all campuses 1st-floor usable (accessible parking, entrance route, main office and at least one accessible restroom) and later to make campuses fully accessible as funding allows. Dyer also said CPS is implementing a board green resolution adopted last year, noting four new solar projects (two roof-mounted, two ground-mounted) among sustainability efforts.

Examples of proposed work: Dyer described roof and envelope projects as large, phased efforts often driven by water infiltration from freeze-thaw cycles; major MEP upgrades can take up to two years and affect indoor air quality; restroom modernization would include hands-free fixtures and accessibility upgrades; space-efficiency work would assess underused or obsolete buildings for potential reconfiguration, replacement or removal.

Funding sources and outside partnerships: presenters said CPS pursues local, state and federal outside funding — examples listed included tax-increment financing, open-space impact funds, state commerce grants, federal community project funding and partnerships with sister agencies such as the Department of Water Management and the Metropolitan Water Reclamation District for certain site projects.

Public input and timeline: presenters said the FY27 planning process began internally in January, included external stakeholder engagement in March and five community meetings in April (including a Spanish-only session April 28). The spring survey (said to have gone live March 18) will be used to inform recommendations that CPS expects to take to the board in May–June, with board approval targeted for the summer months.

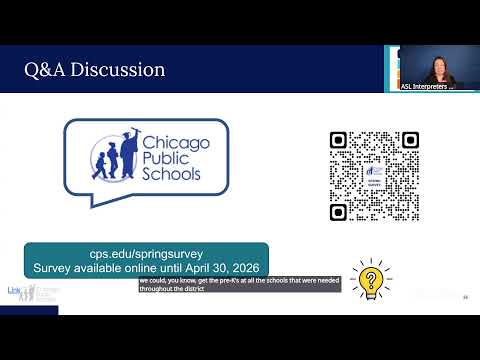

What attendees asked: officials answered questions on how community priorities affect allocations (survey results, academic alignment and funding availability drive recommendations), whether community members can advocate for outside funds (they can, e.g., through alderpeople or state and federal representatives), where to find opportunity-index scores and facility reports (cps.edu), and how playgrounds and concrete work fit into categories (playgrounds into the playground program; ADA-driven surface work may fall into accessibility categories).

Next steps: CPS asked the public to complete the spring survey before April 30 and said project recommendations will be presented to the board this summer. The district said updated facility condition assessments are being completed and will be posted when available.

(Reporting based solely on the CPS community session transcript; direct quotes are attributed to speakers who introduced themselves during the meeting.)
