CPS officials outline FY27 capital priorities as community survey opens amid multi‑billion‑dollar backlog

Chicago Public Schools (CPS) · April 22, 2026
AI-Generated Content: All content on this page was generated by AI to highlight key points from the meeting. For complete details and context, we recommend watching the full video. so we can fix them.

Summary

Chicago Public Schools leaders presented 12 FY27 capital‑budget categories, said the district faces multi‑billion‑dollar repair needs, and urged residents to complete a March 18–April 30 survey to help prioritize projects for a summer board decision.

Chicago Public Schools officials on the district’s FY27 capital‑budget outreach meeting reviewed the condition of the system’s aging buildings, the proposed budget categories for next year and how community input will shape project priorities.

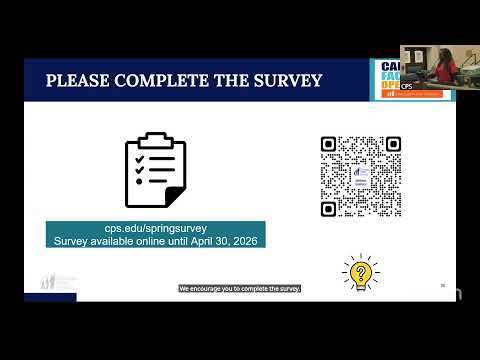

“We need your feedback,” said Ivan Hansen, chief facilities officer, opening the meeting and asking attendees to complete a district survey that runs through April 30. Hansen said CPS maintains roughly 62 million square feet of facilities, with an average building age of about 86 years and an estimated backlog of deferred maintenance in the multi‑billion‑dollar range.

Why it matters: CPS officials told attendees that capital funding has varied markedly year to year, complicating long‑range planning, and that prioritization is necessary because available funds cannot address all identified needs. Hansen said the FY26 capital budget approved by the board was about $500 million; CPS leveraged roughly $55 million in outside funding for that year.

Key numbers and categories: Presenters summarized facility assessment findings and broad cost estimates for the portfolio. They cited different figures at various points in the meeting — “over $3 billion,” “about $3.2 billion,” and a later figure of roughly $3.7 billion — for immediate critical repairs (roofs, windows, mechanical systems). Dier, the executive director for capital planning and construction, outlined 12 proposed FY27 budget categories, including roofs and building envelopes; mechanical, electrical and plumbing systems; ADA accessibility work; restroom renovations; programmatic classroom improvements; IT and security; playgrounds and site improvements; parking lot replacements; student athletics and natatorium work; modular refurbishment; energy efficiency and sustainability; and space‑efficiency studies.

Accessibility and equity: Officials said CPS has used an equity index and the Educational Facilities Master Plan to steer funding toward schools “furthest from opportunity,” noting that from FY21–26 the capital planning team marshaled more than $2 billion of work targeted by the index.

Examples and timing: Dier said roof and envelope projects are complex, often completed over one to two summers; mechanical and MEP projects can take up to two years. CPS plans four solar projects this summer (two roof‑mounted and two ground‑mounted) as part of sustainability work embedded across projects. ADA work is being phased: the district’s first goal is to make each school’s first floor usable (accessible parking and entrance, an accessible route, public and all‑gender restrooms) before pursuing full building accessibility.

How priorities are set: Presenters said CPS prioritizes projects using the facilities condition index, the opportunity/equity index and district priorities, and that facilities staff undertake interim repairs when full capital projects are not immediately possible. Dier encouraged community members to pursue outside funding — including aldermanic, state and federal earmark channels — for large site projects such as playground renovations and turf fields to improve the chance of board approval.

Next steps: The district opened the FY27 survey March 18 and will accept responses through April 30. Officials said recommendations will be presented to the CPS board for approval in July or August.

Ending: Officials closed by thanking attendees and repeating the request that school communities complete the survey to inform FY27 capital priorities.
